Hasta pronto

20170213_204009

Last night: poetry festival in front of Iglesia Merced

20170213_110600

Last day: my walk up to check progress of the 3 latrines in Pantanal

20170213_110514

LEG’s first learning center in barrio Escudo, just down from Pantanal.

20170213_104222

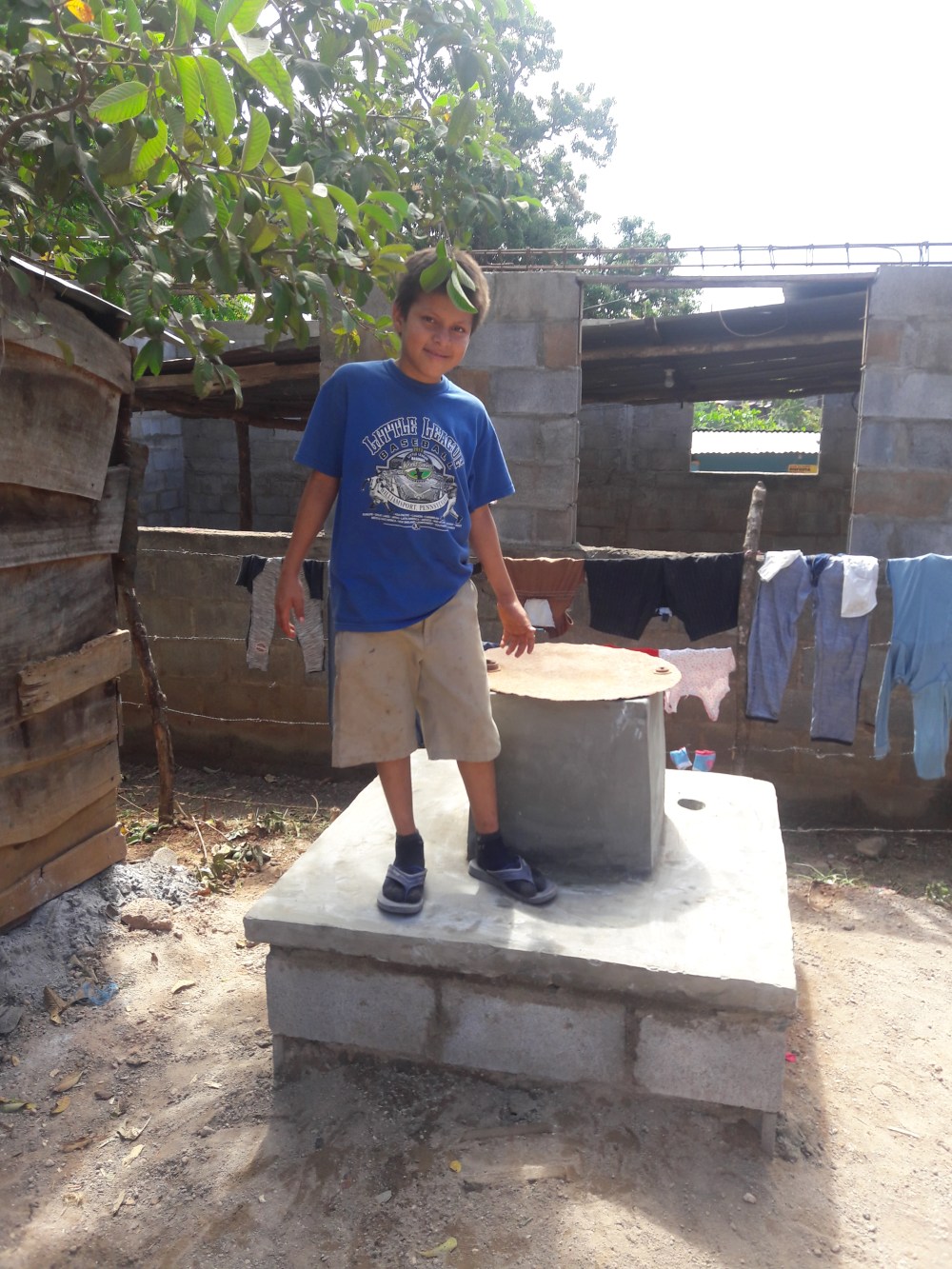

1st of 3 latrines almost done. Turns out one of my 4th grade summer school students, Henry, lives at this house.

20170212_141723

Last isletas boat ride Sunday. Ometepe Island in distance.

20170211_195803

House blessing Saturday night. Long night.

Three new latrines for 4 families.

Despite a very busy 2 weeks for La Esperanza Granada with school starting this Monday, new volunteers pouring in, and another learning center set to start construction this month, staff were able to track down the final house cost ($3300) and get proposals for the remaining $1500. With much input, we decided on 3 new latrines for 3 Nueva Esperanza families. Work started yesterday and should be done by Monday. We fly to LA Tuesday. Here are some pics from today.

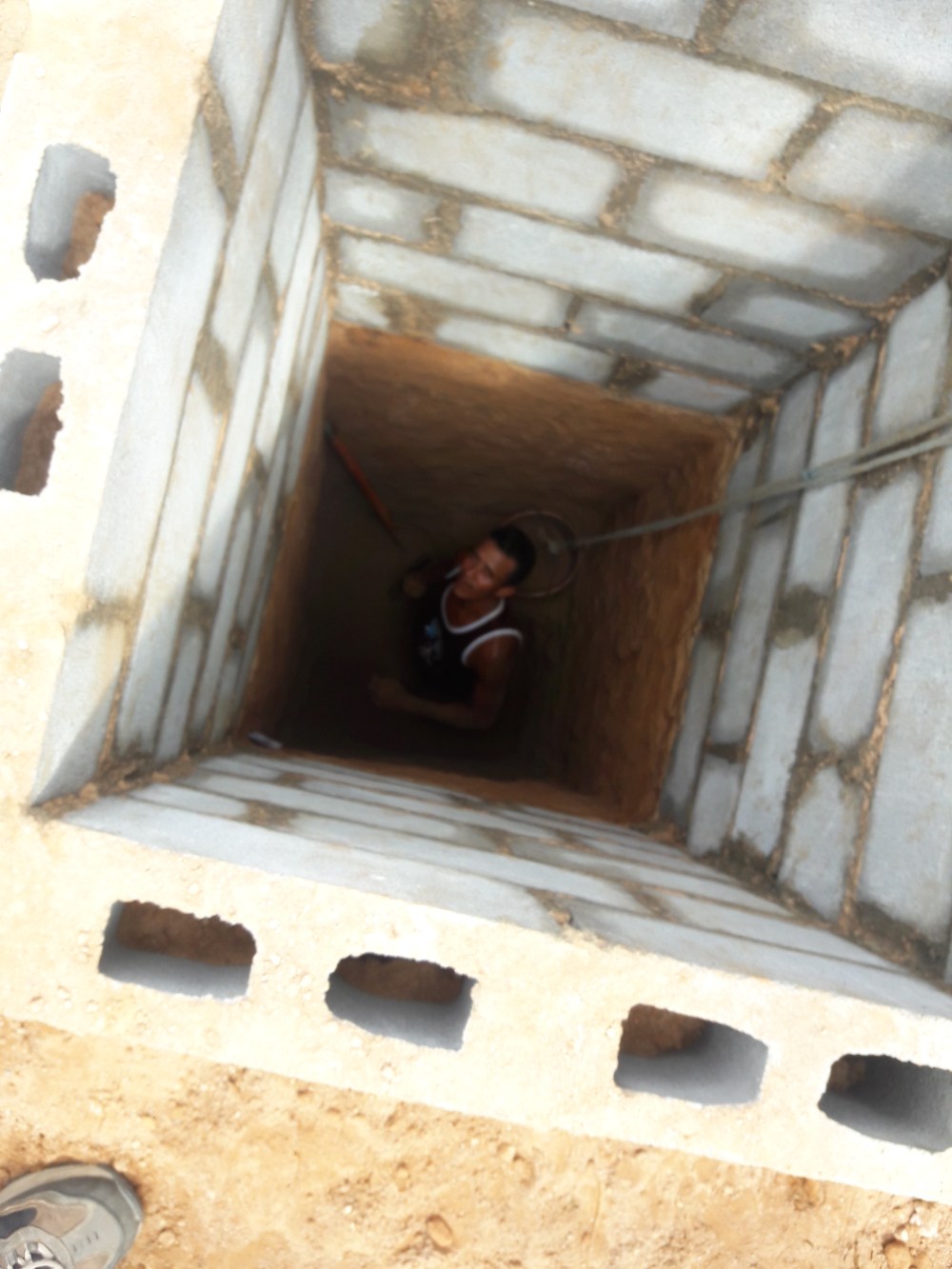

20170210_101912

This latrine will serve 2 families, about 15 people, living on a good sized lot just down from the school.

20170210_103551

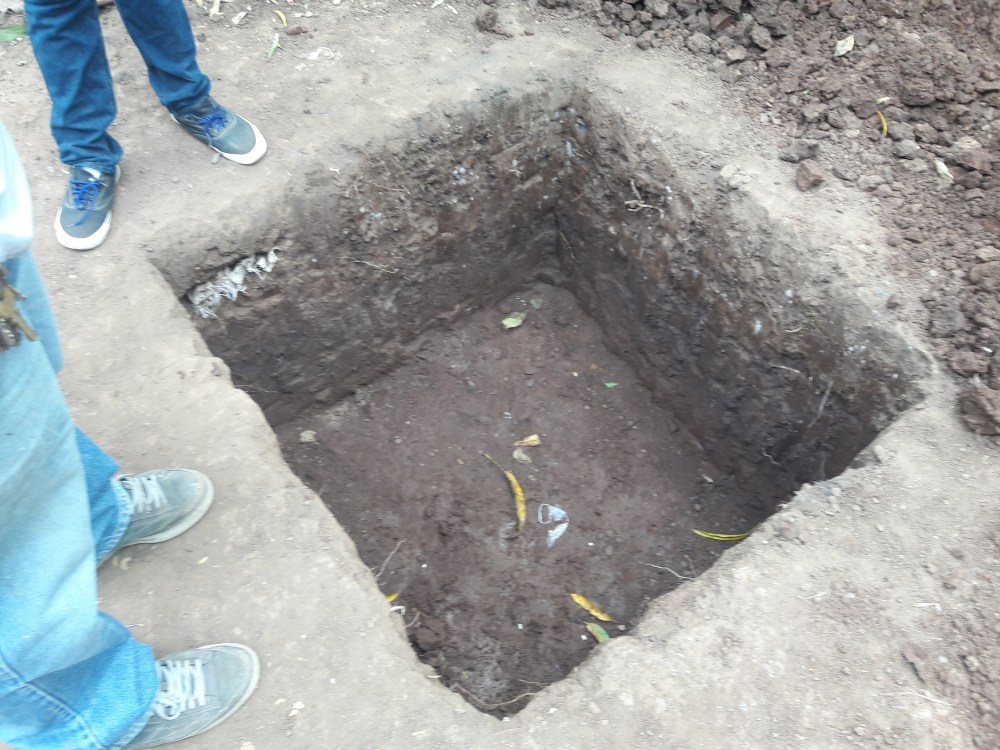

This is the 2nd latrine that was just started in very hard dirt. It will serve a family of 8.

20170210_103024

This is the first one again, with 2 families.

20170210_10361820170210_10195220170210_103954

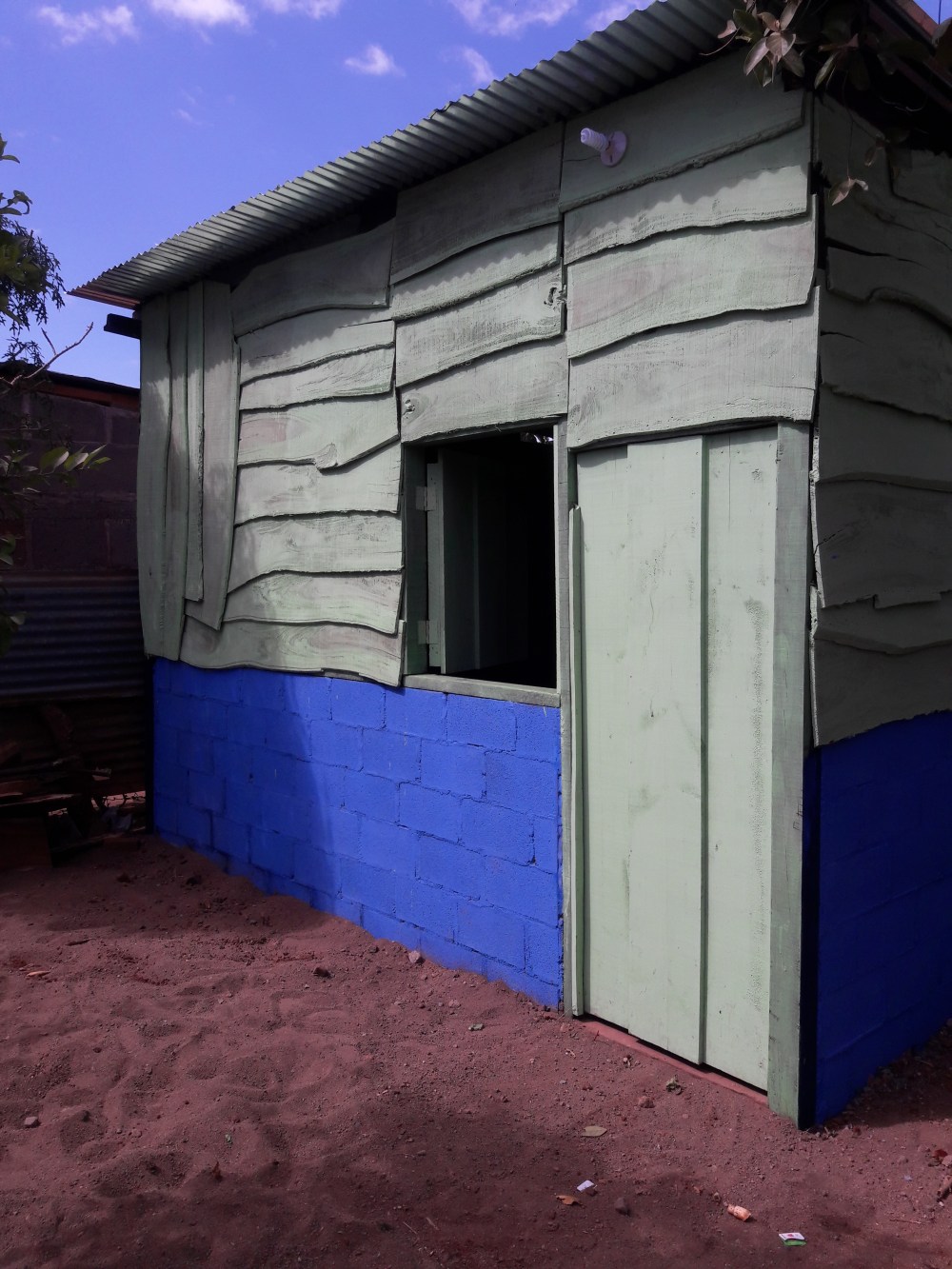

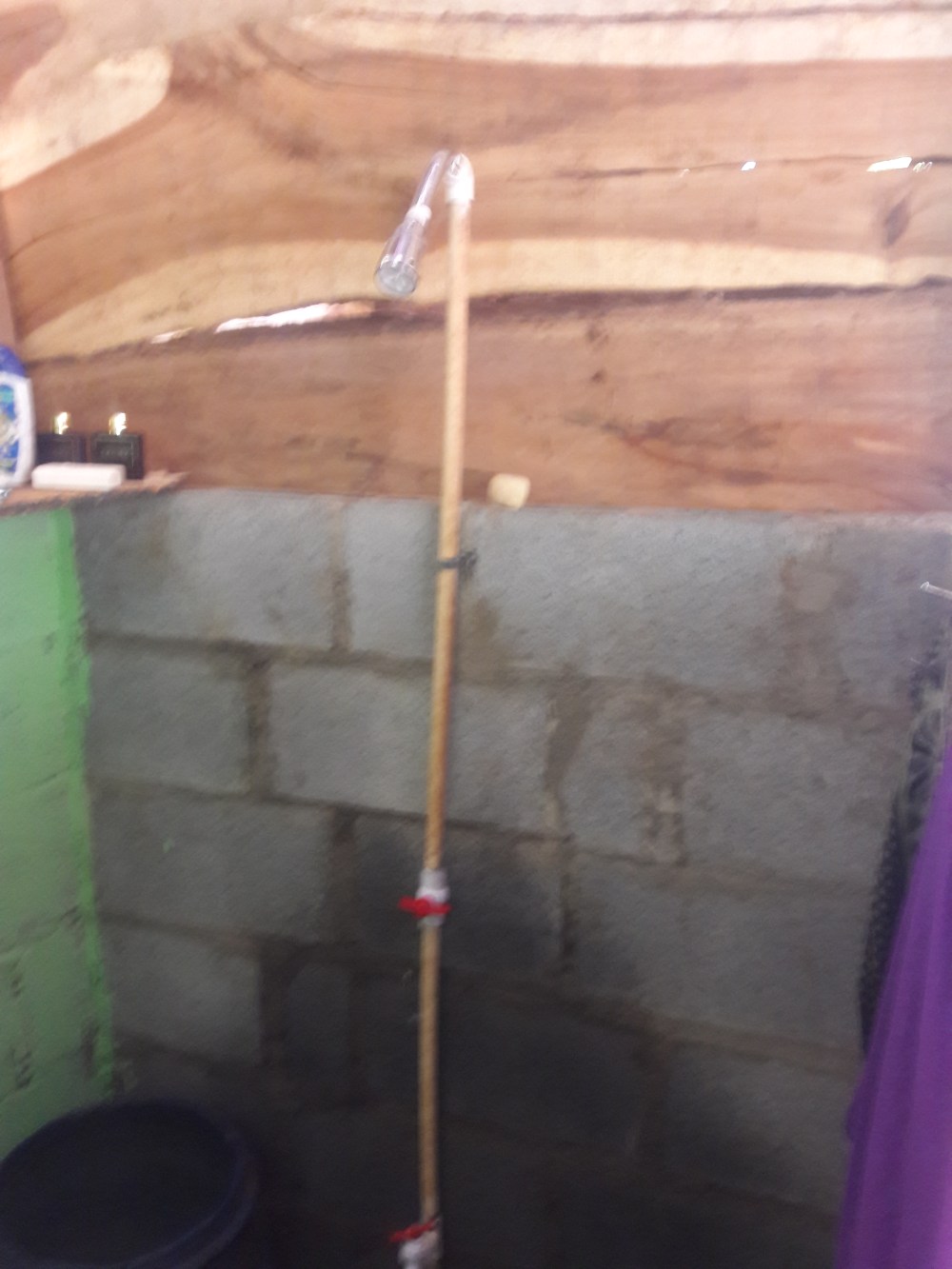

20170203_133552

New shower. Before: bucket in dirt

20170203_133756

Back door and preserved banana tree.

20170203_133452

New bunk beds. We gave them 4 new picture books with the beds and all agreed to read at least one per night before bed.

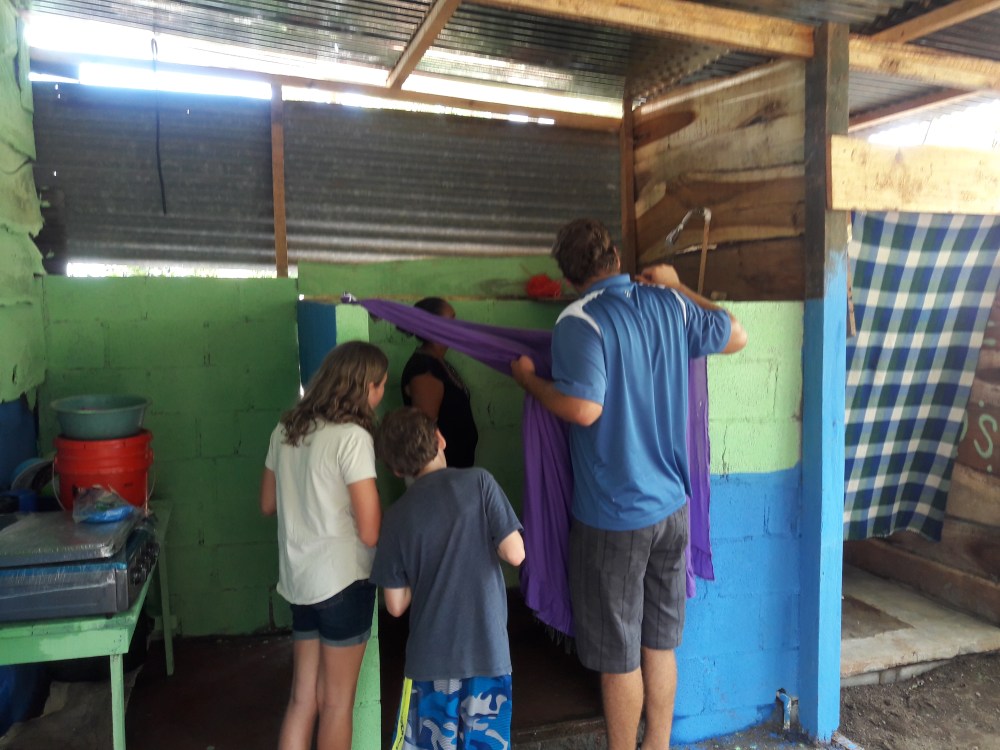

20170203_133515

Left to right: New gas stove area; new shower; new latrine.

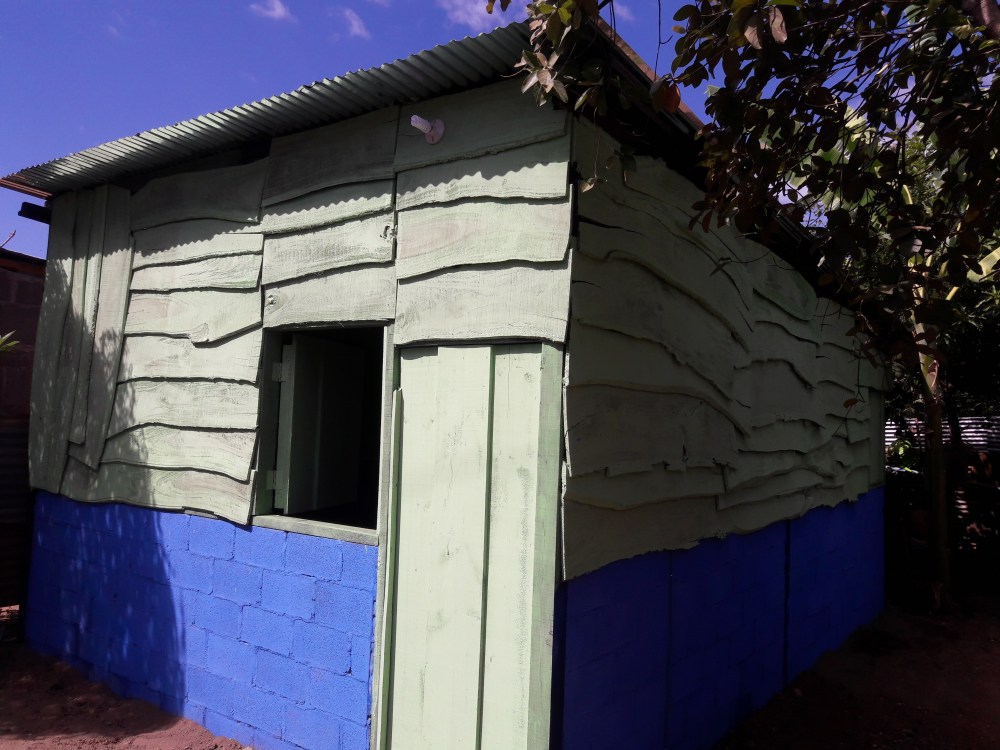

20170203_133243
20170203_133112

Front door.

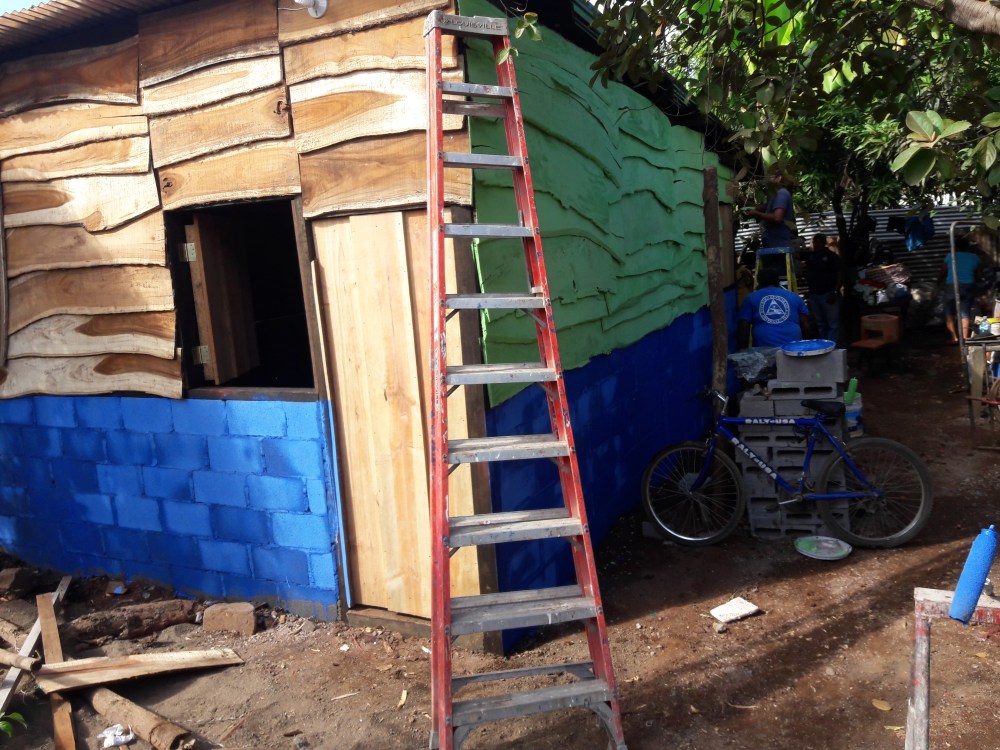

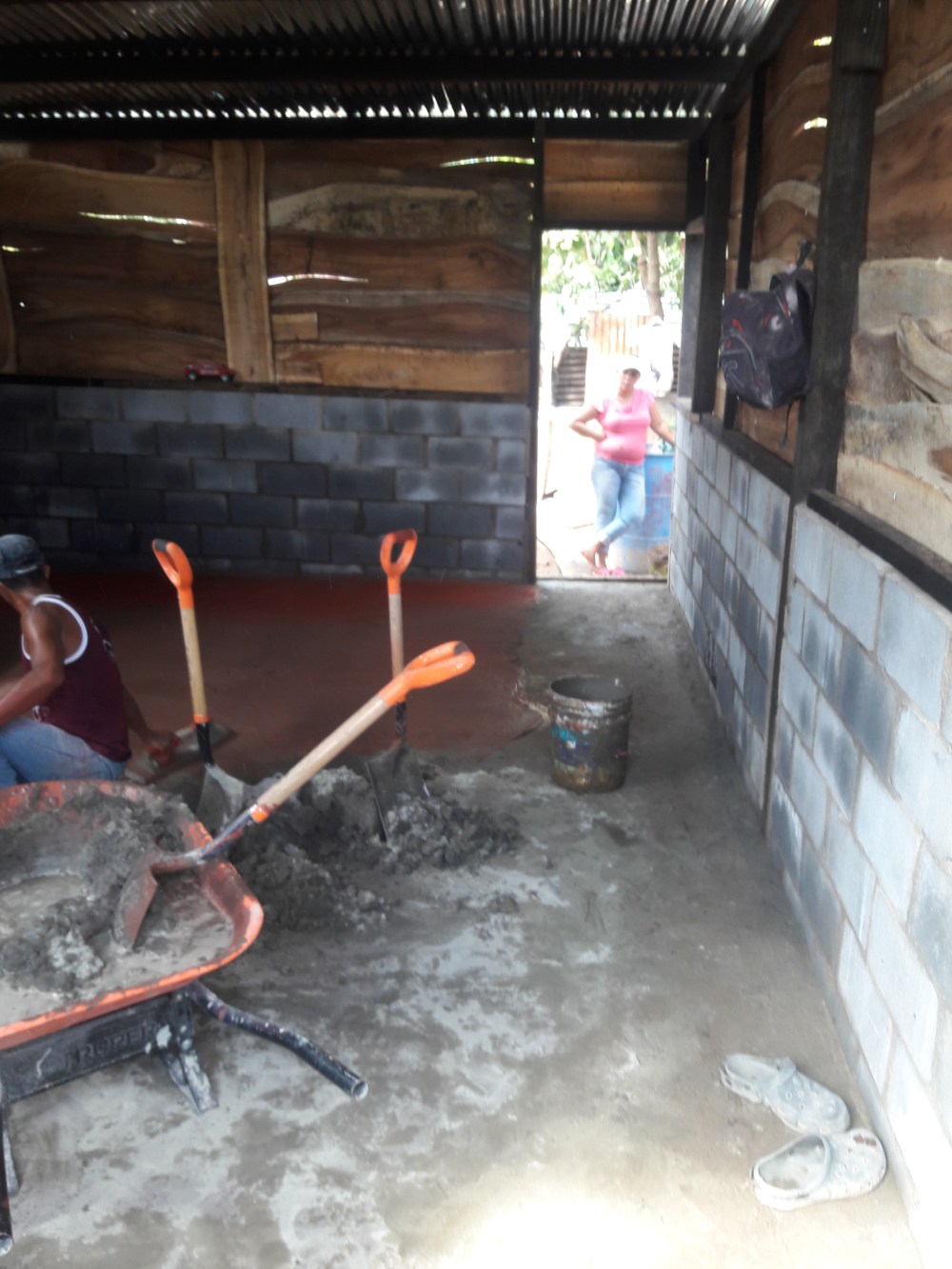

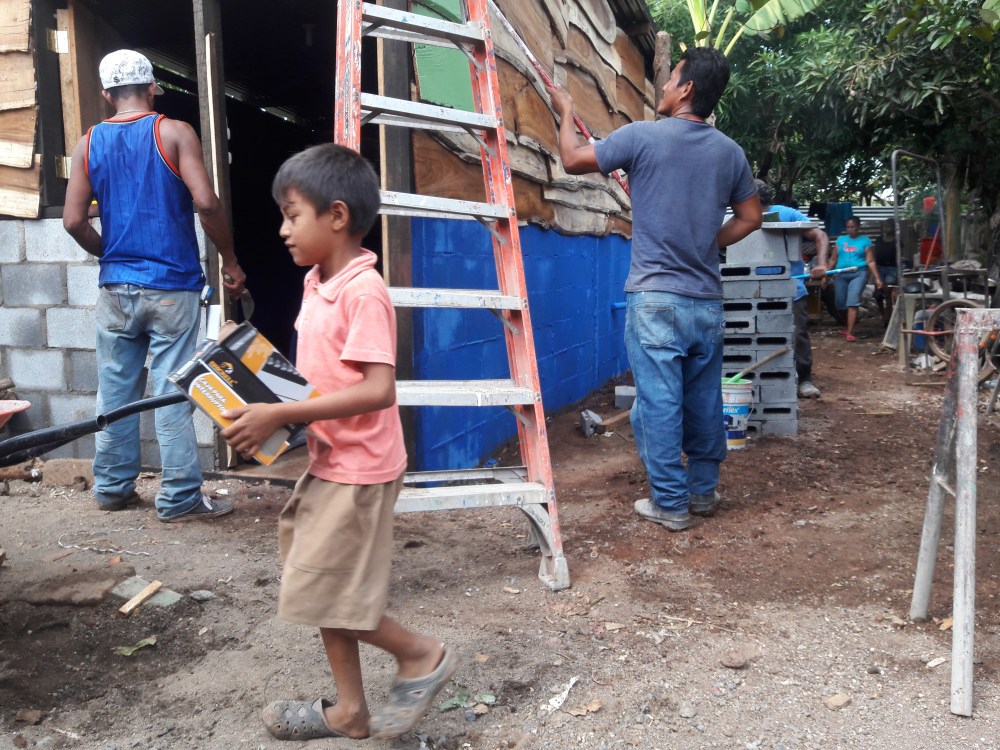

Tuesday construction update

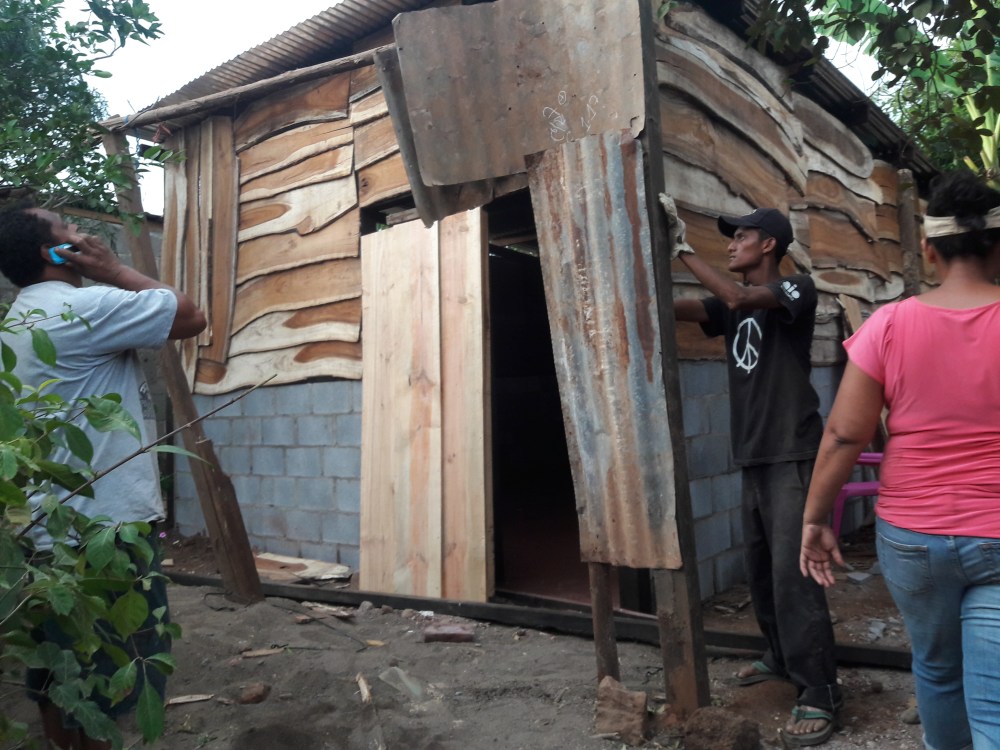

Despite losing my wallet today somewhere between the house and kids school, today was pretty good for house progress.  After re-tracing my path twice and cancelling my cards, I met with the LEG director and the contractor. We decided to order a gas stove tank set up and a locally made ceramic super efficient wood stove contraption: https://www.comarcasapoyo.org/coci-nica-english. We also agreed to get a bunk bed set up for the Erick Antonio and Darling.

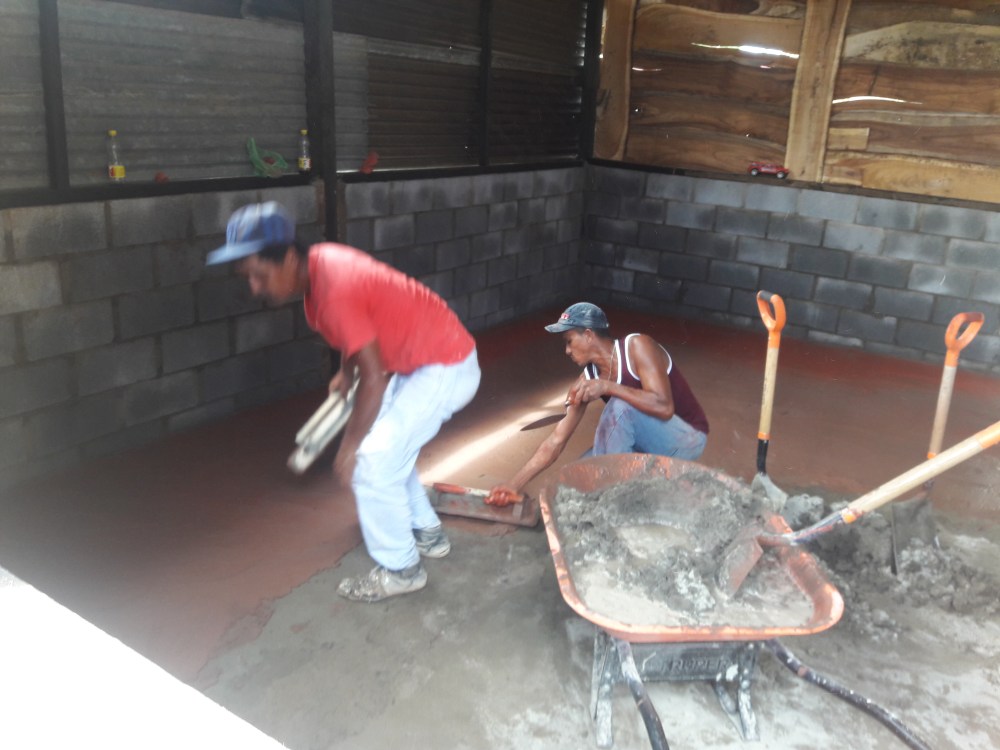

The contractor said he had a crew available this afternoon and with the materials left over at the site he offered to do a concrete floor today for $100. He called the labor charge, about $33, “un regalo”, a gift.

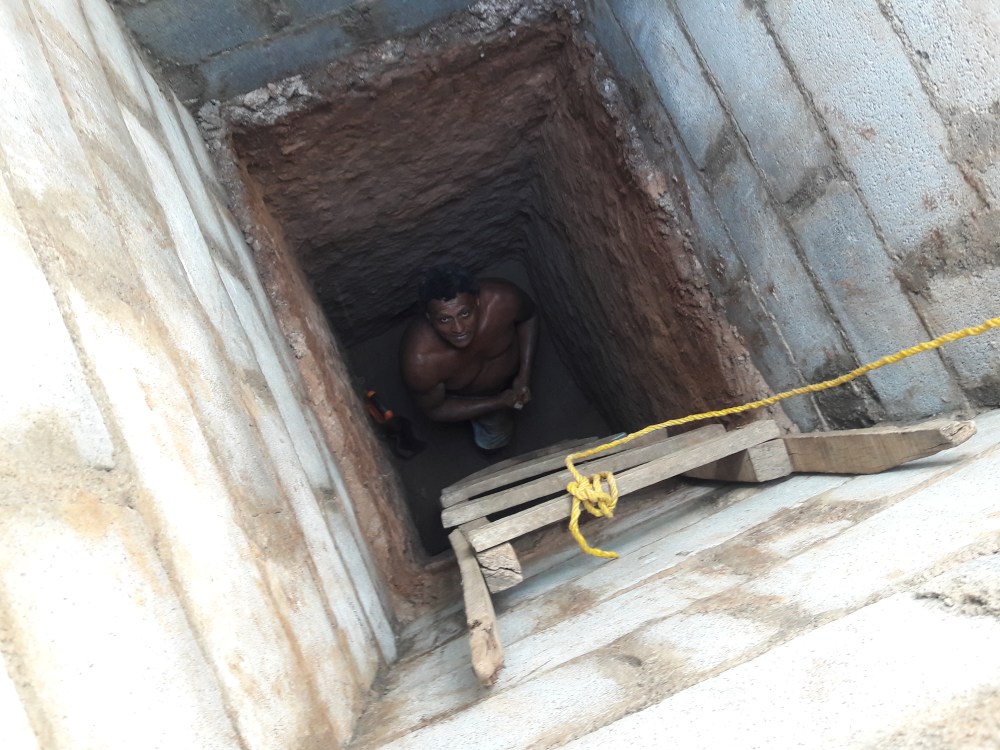

20170131_110355

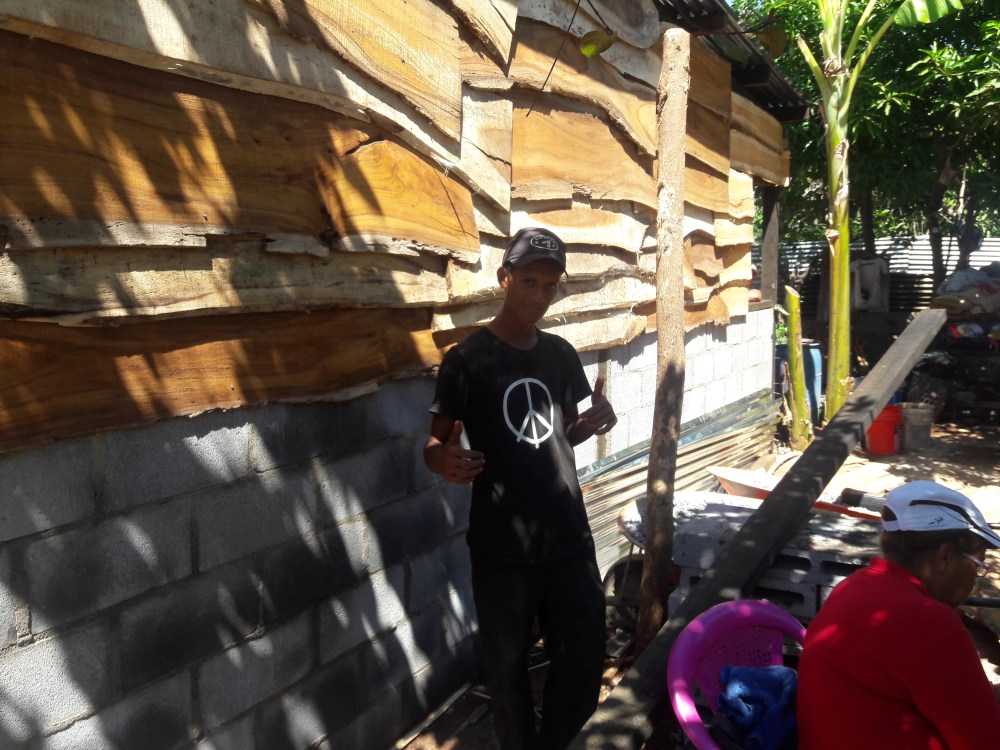

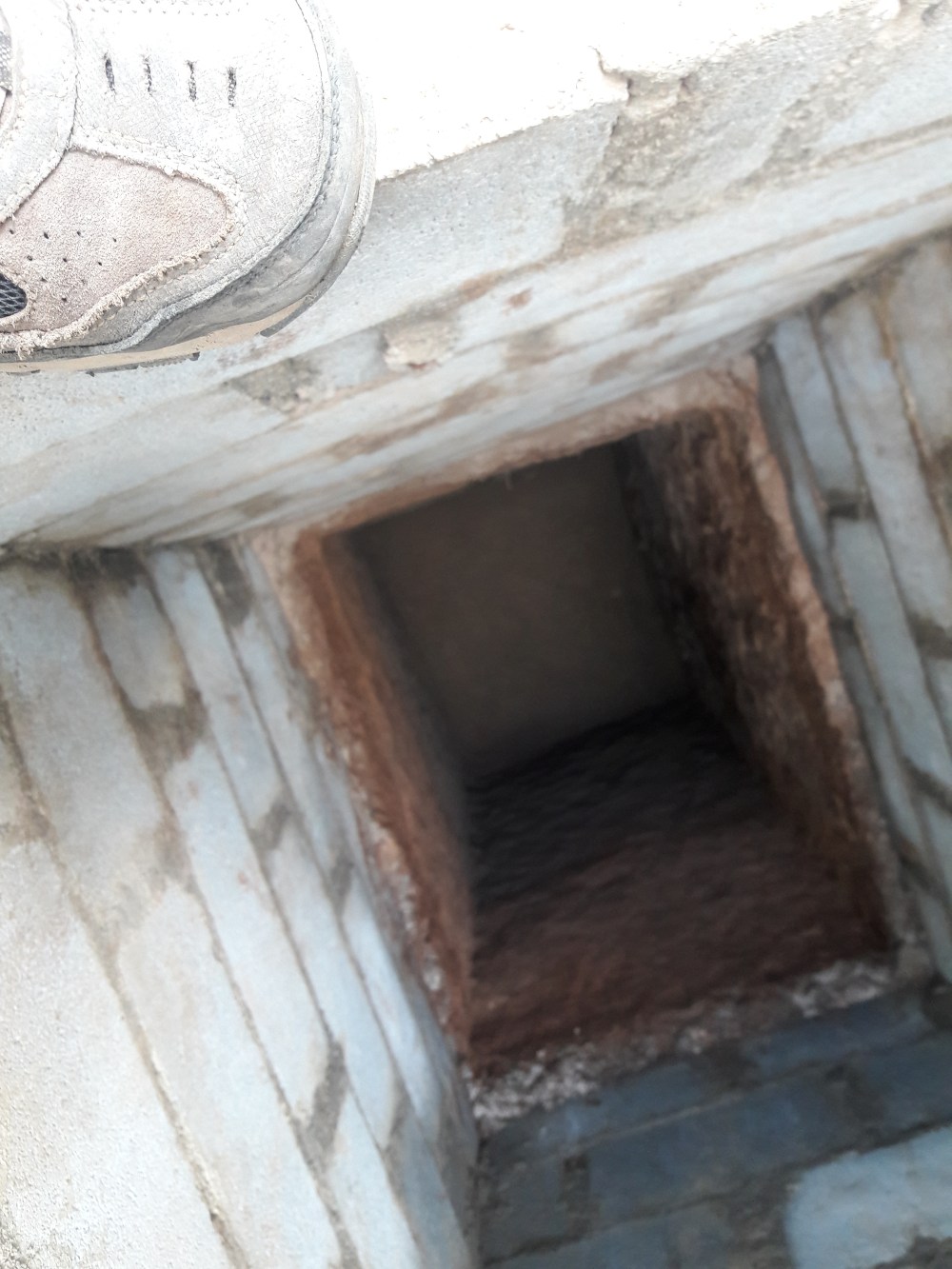

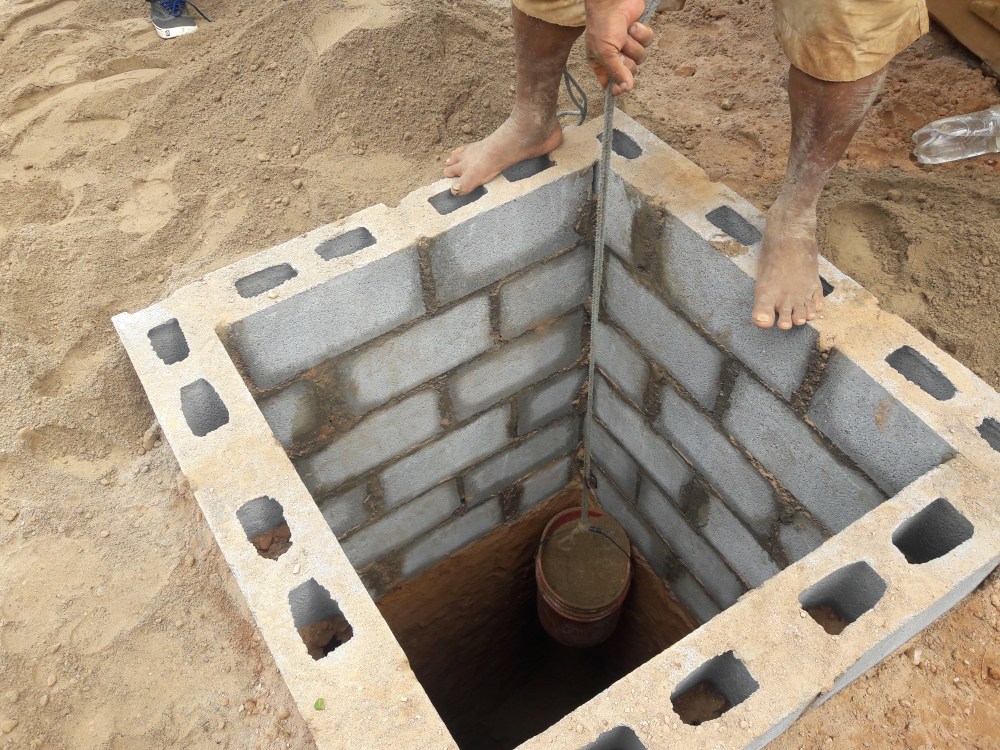

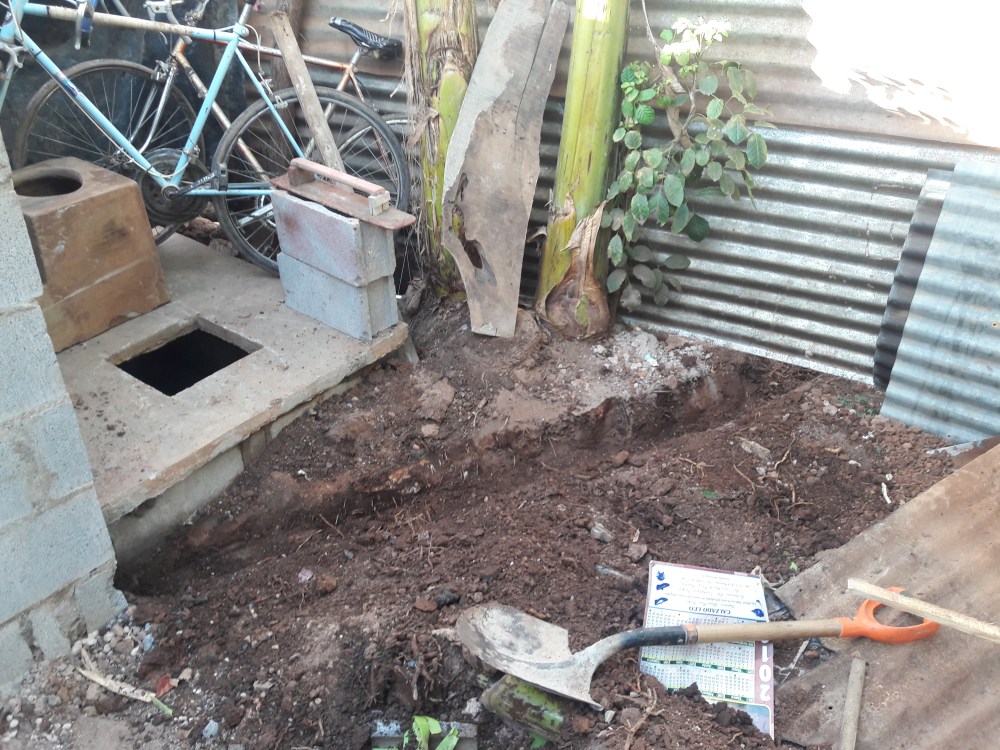

In about 6 hours of work, he knocked out 7 feet. He said we should stop at 13 feet because the water table might get in if we go further. Which is BS according to Darvin. The old latrine was 18 feet deep.

20170131_150140
20170131_150800

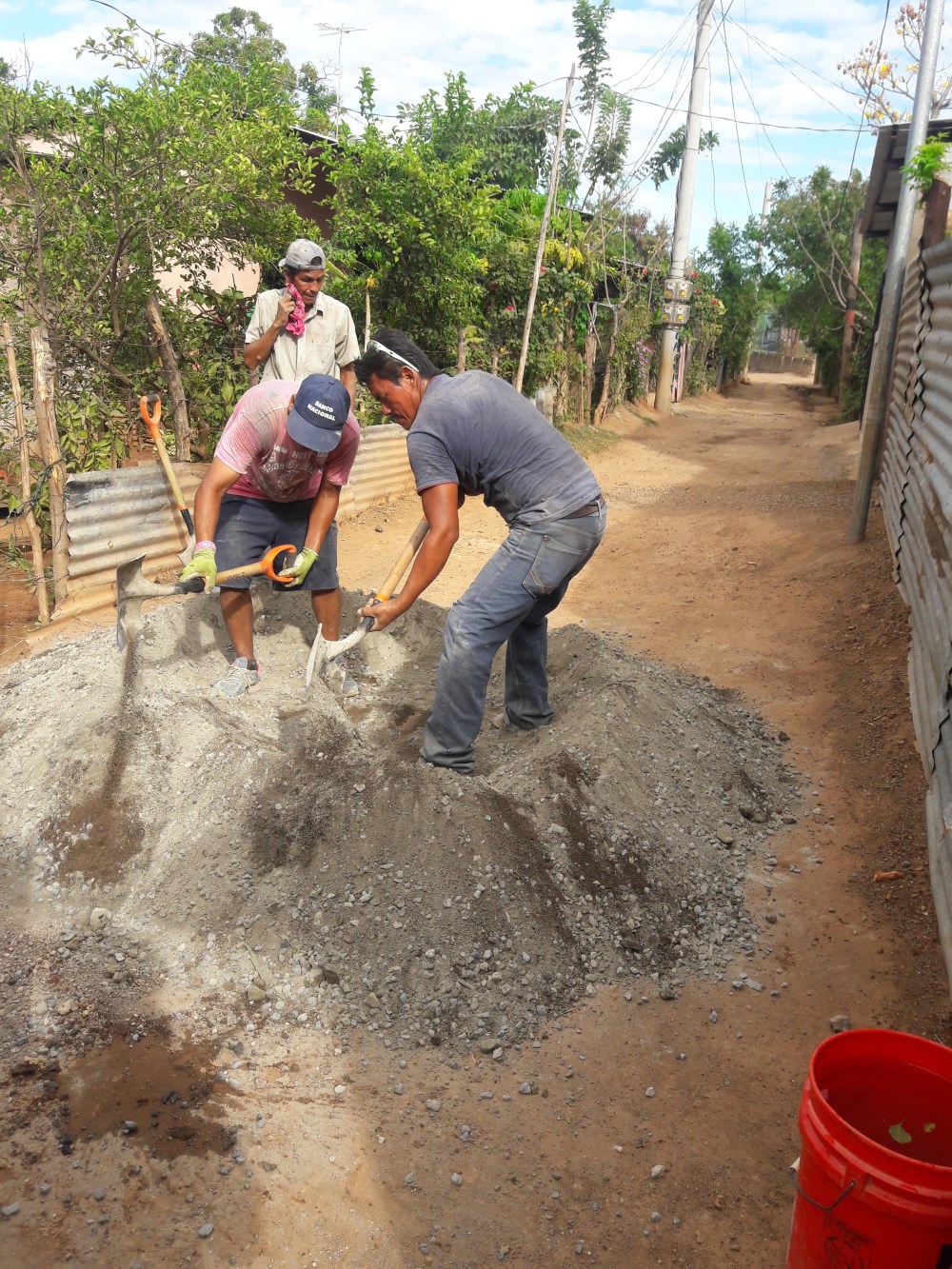

The 4 man concrete crew finally showed up in a big truck around 3pm with all the supplies and tools. They worked extremely fast mixing sand, rock, water and cement in the street and carried bucket loads to the house.

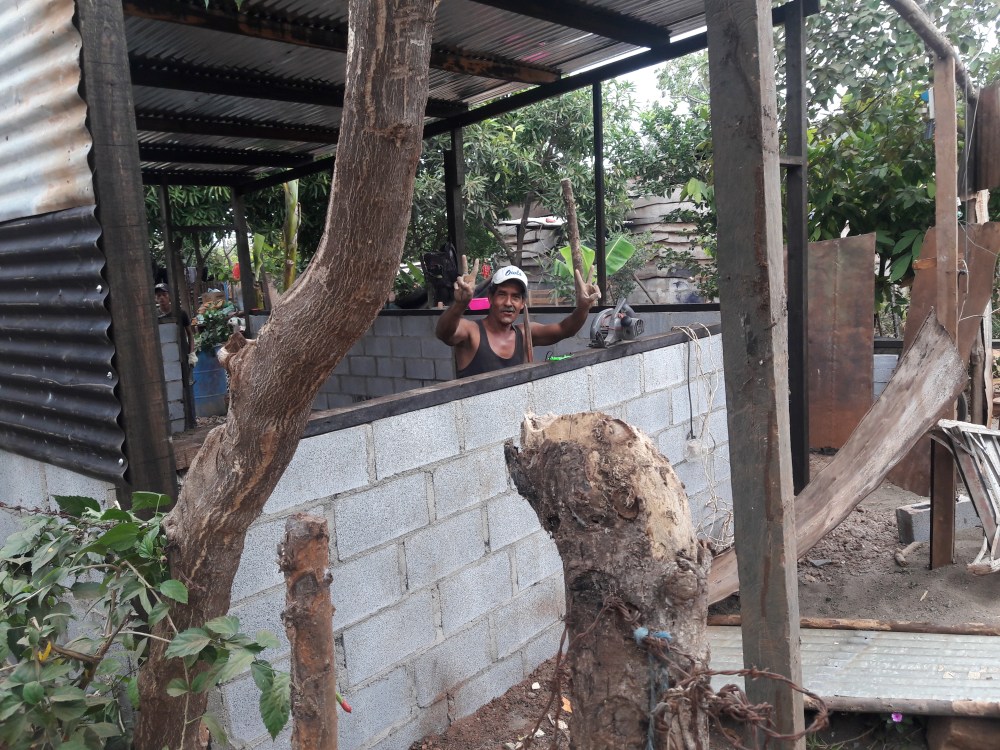

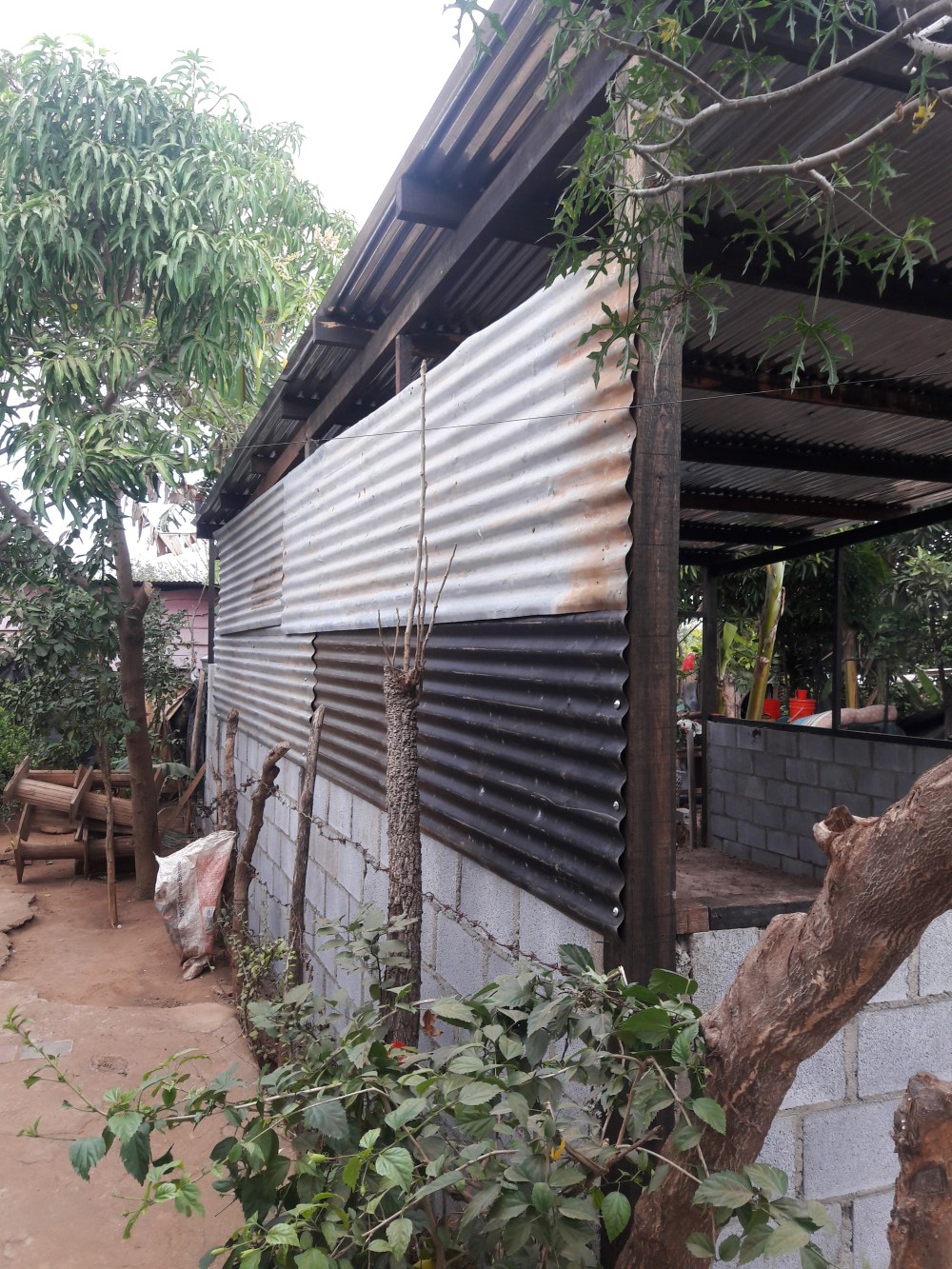

20170131_144715
20170131_165139

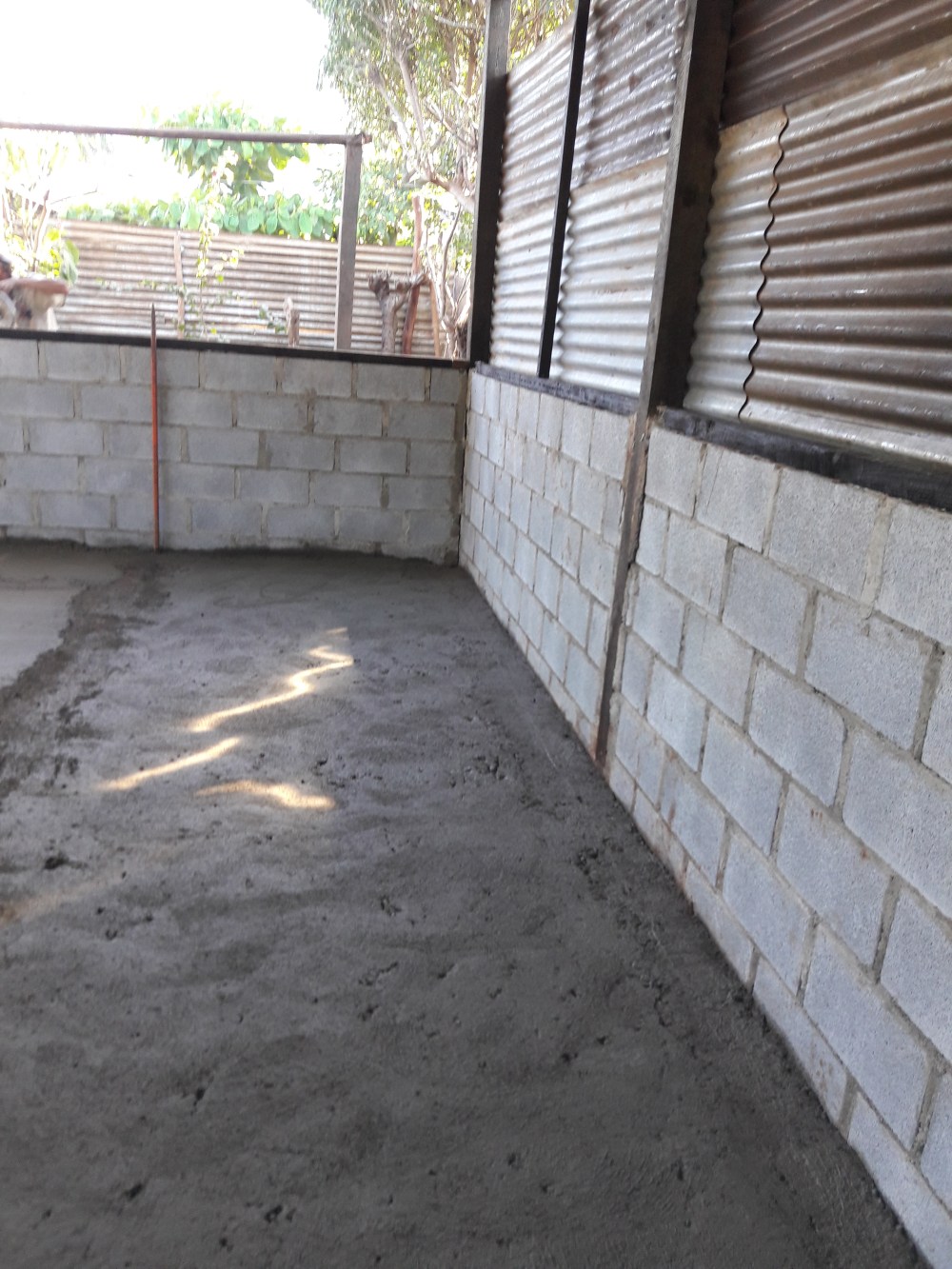

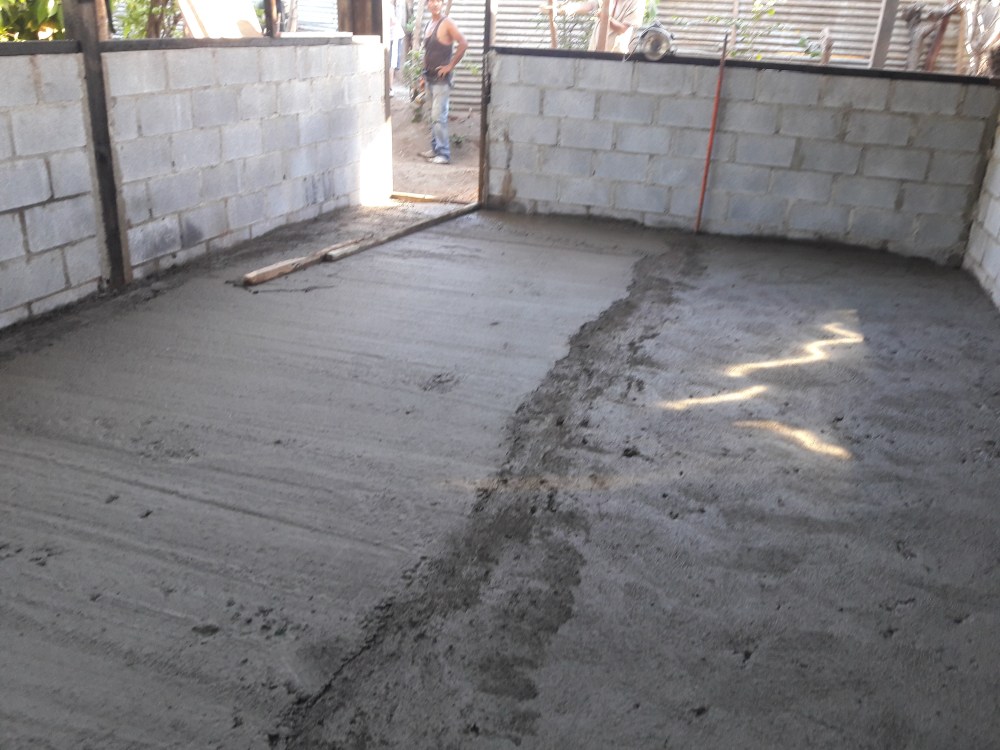

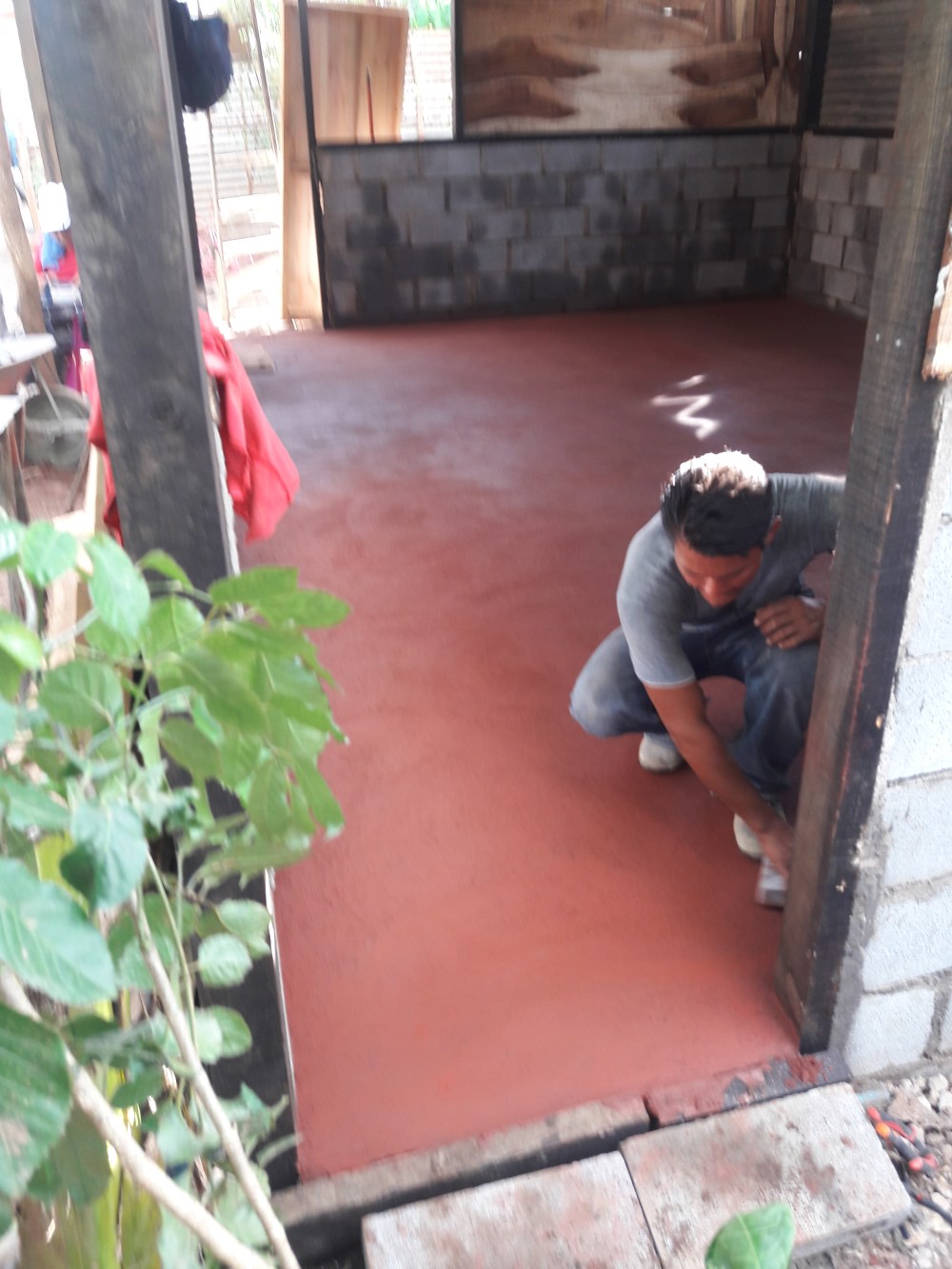

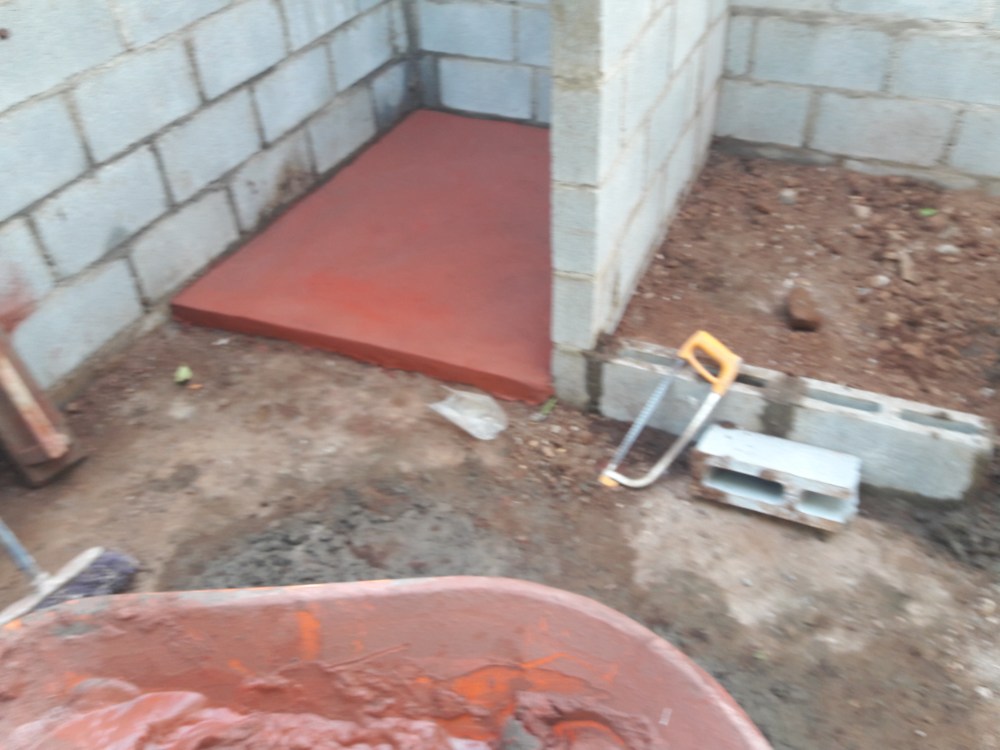

The 3 inches of concrete was done in about 2 hours. Another finish layer and color will hopefully get done tomorrow.

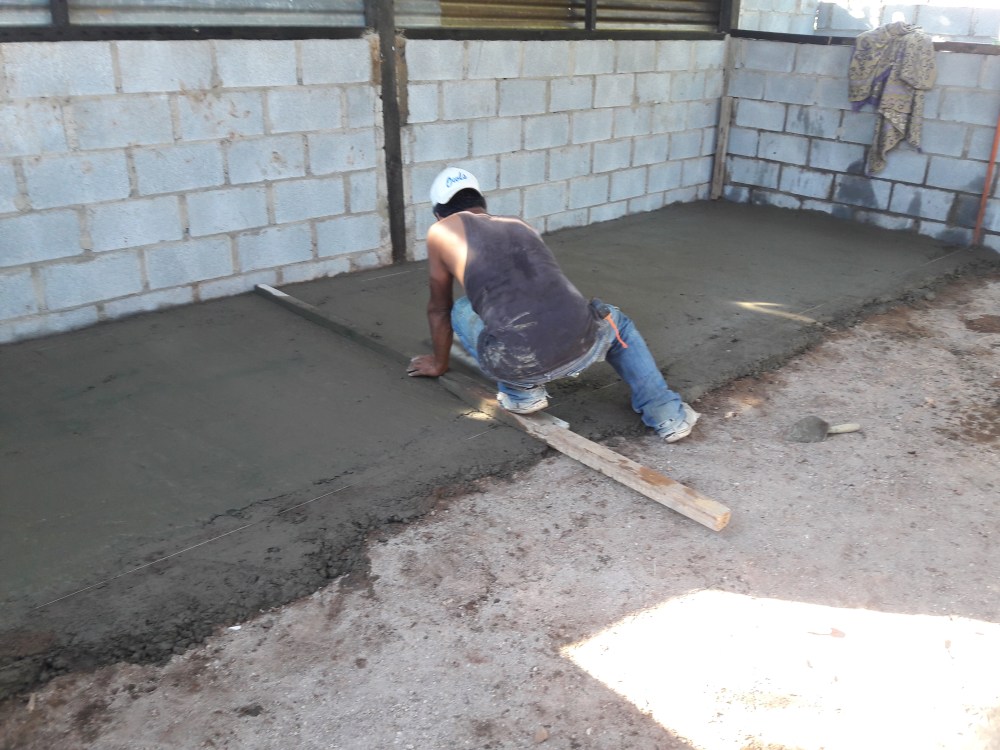

20170131_16512620170131_154959
20170131_144718

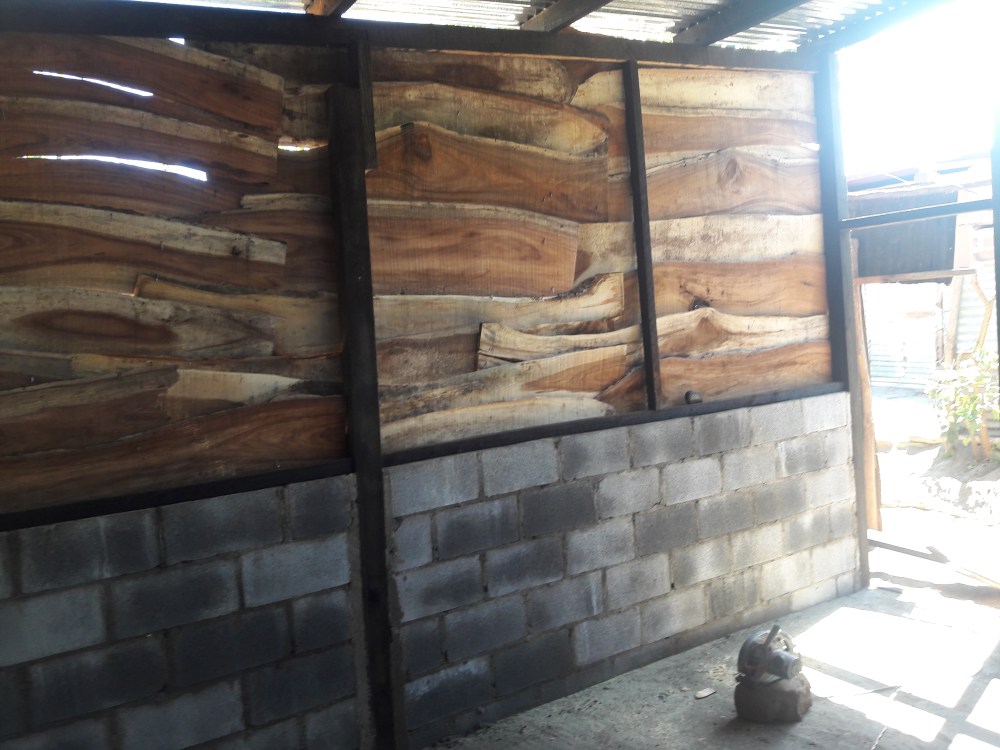

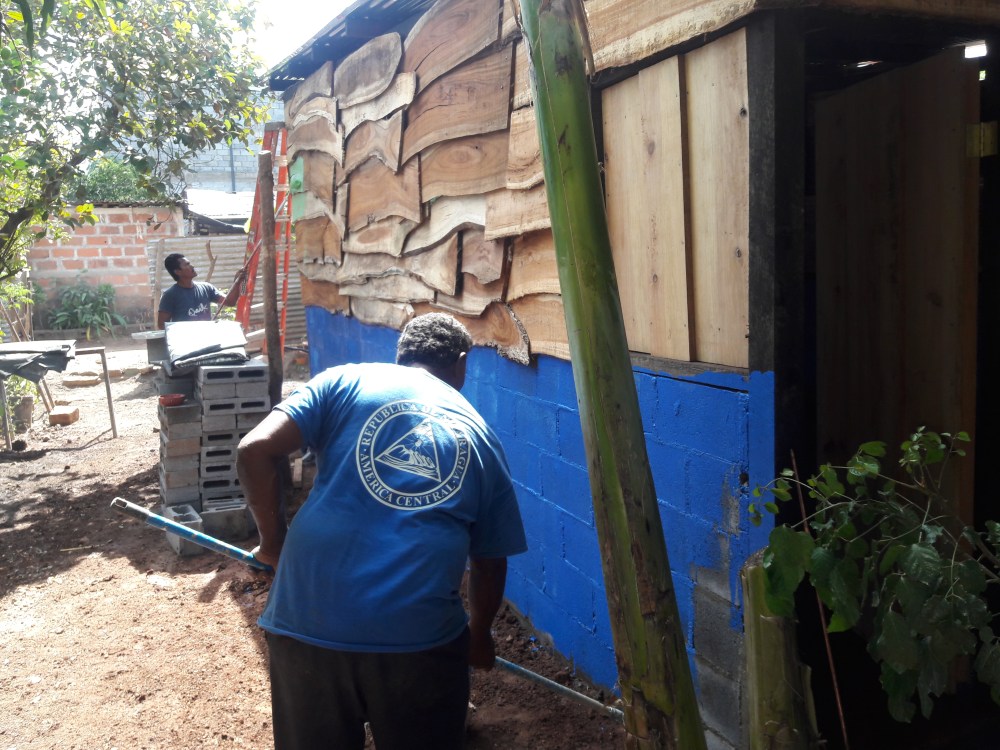

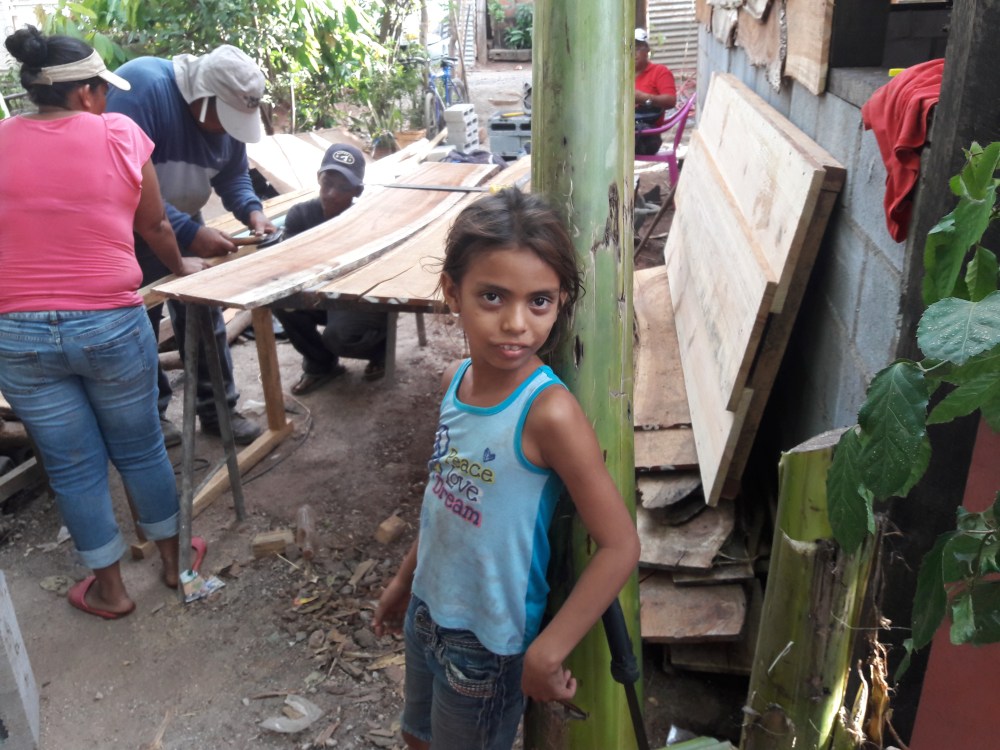

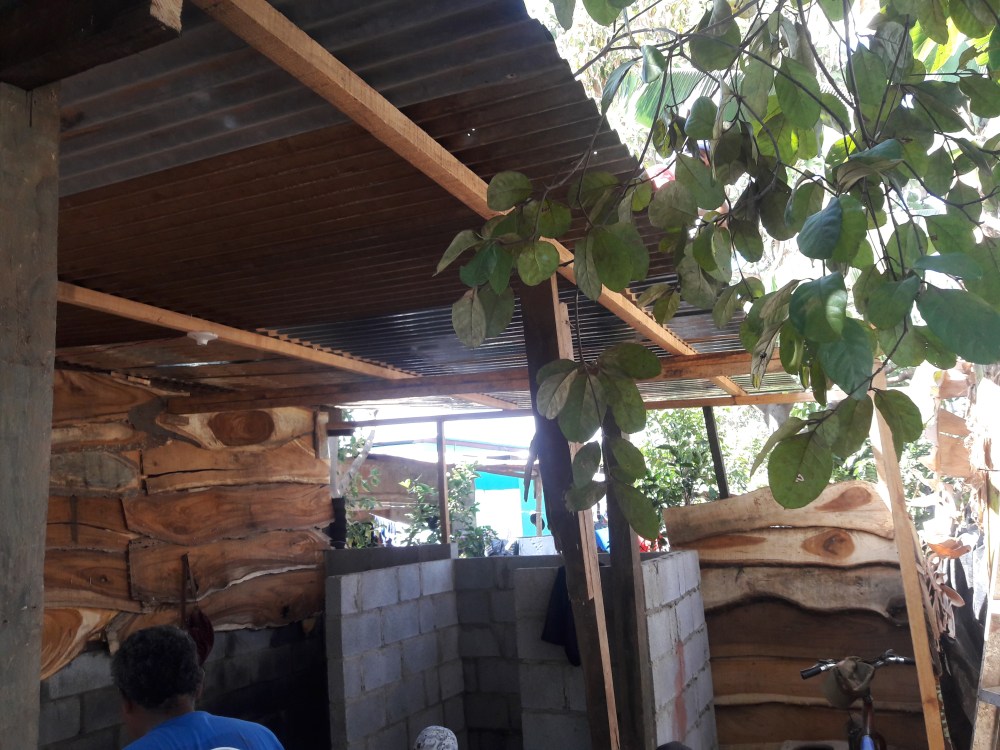

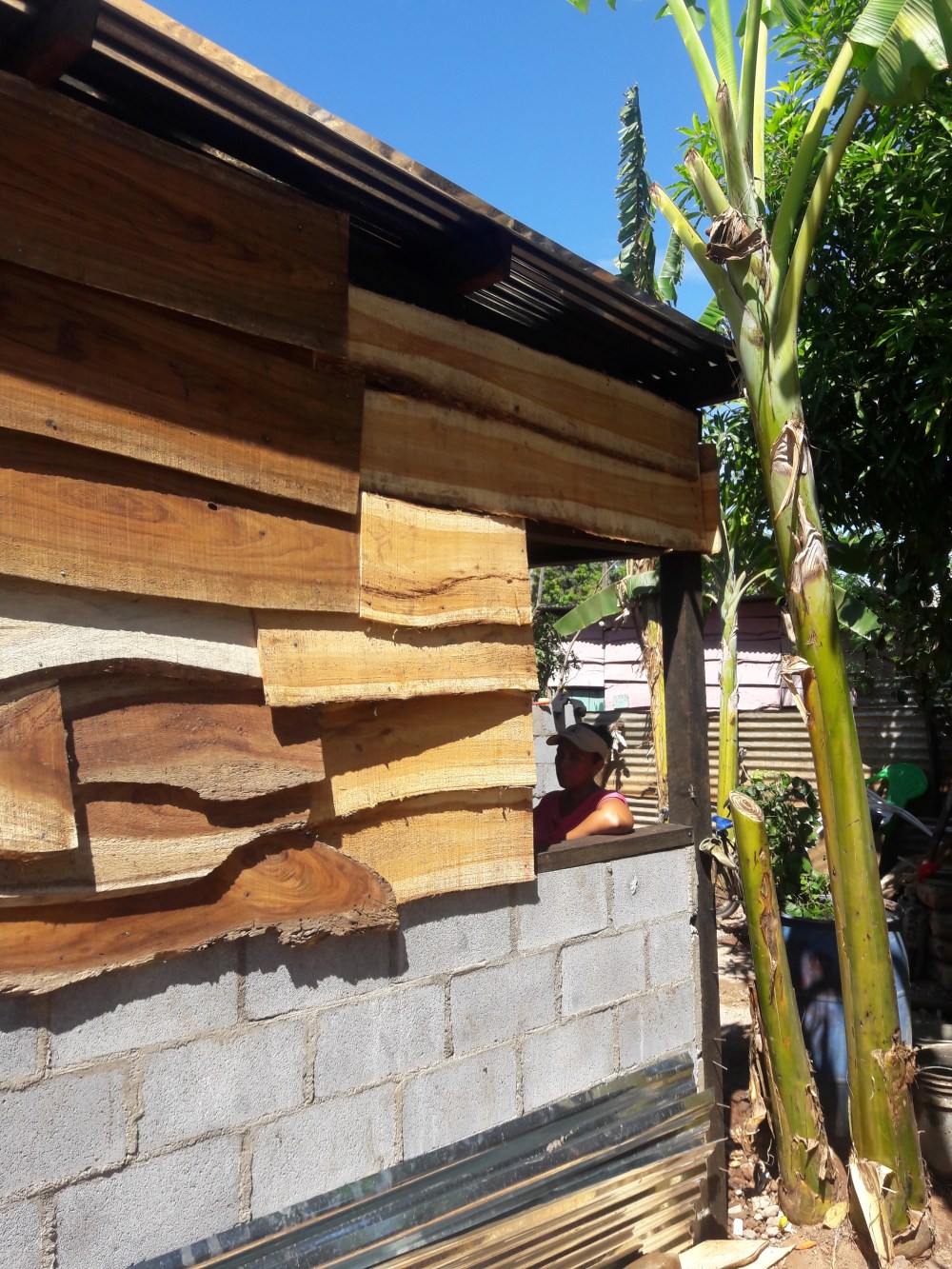

After protesting this yesterday, I was told all agreed this was the best approach to finish this wall, which faces the neighbor they don’t seem too friendly with. More importantly, the wind comes from the other direction. These are the best peices from the old roof. The other 3 walls will be done with the crappy wood planks, which I’m told is best to let the breeze in.

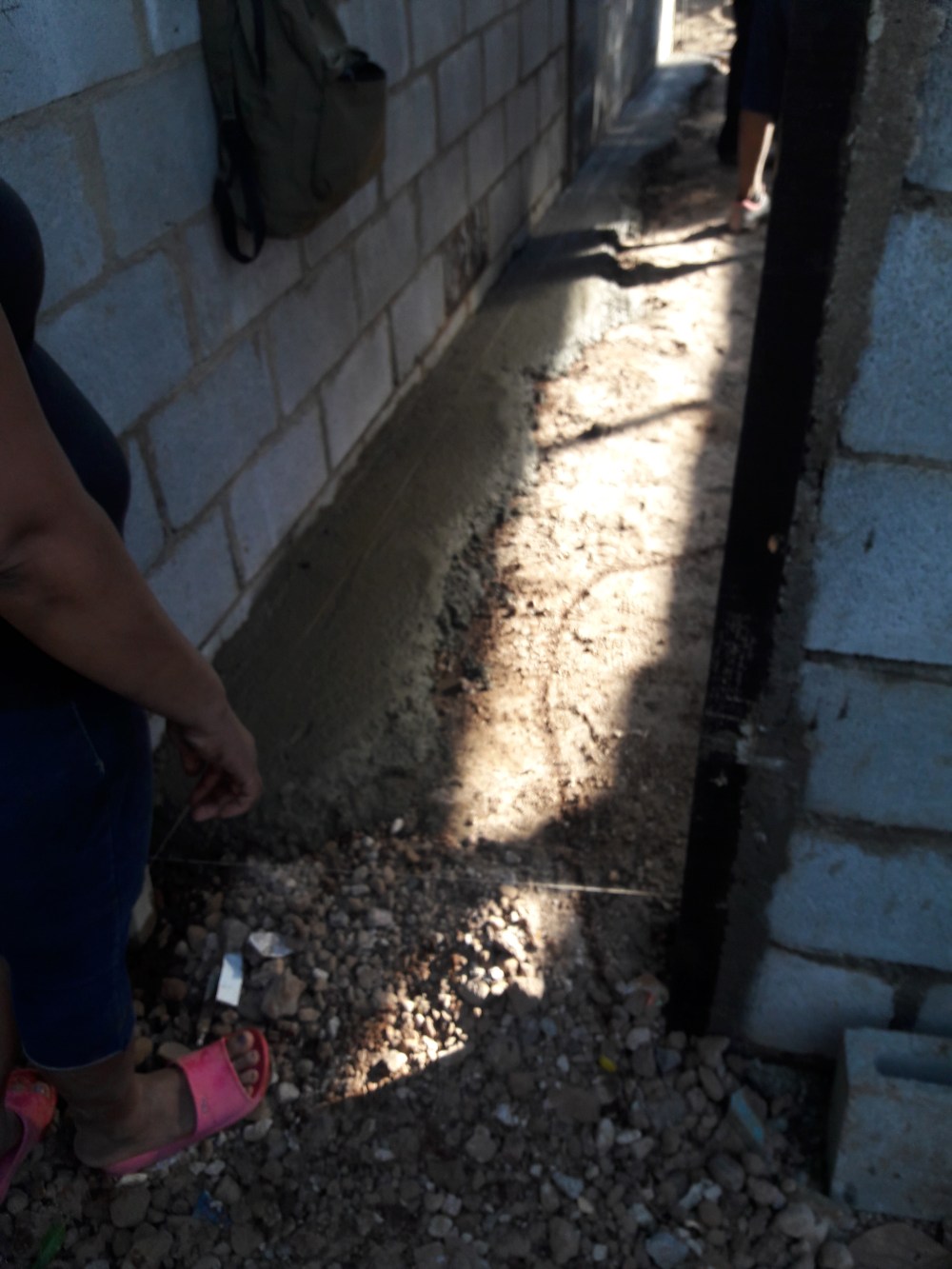

20170131_153227

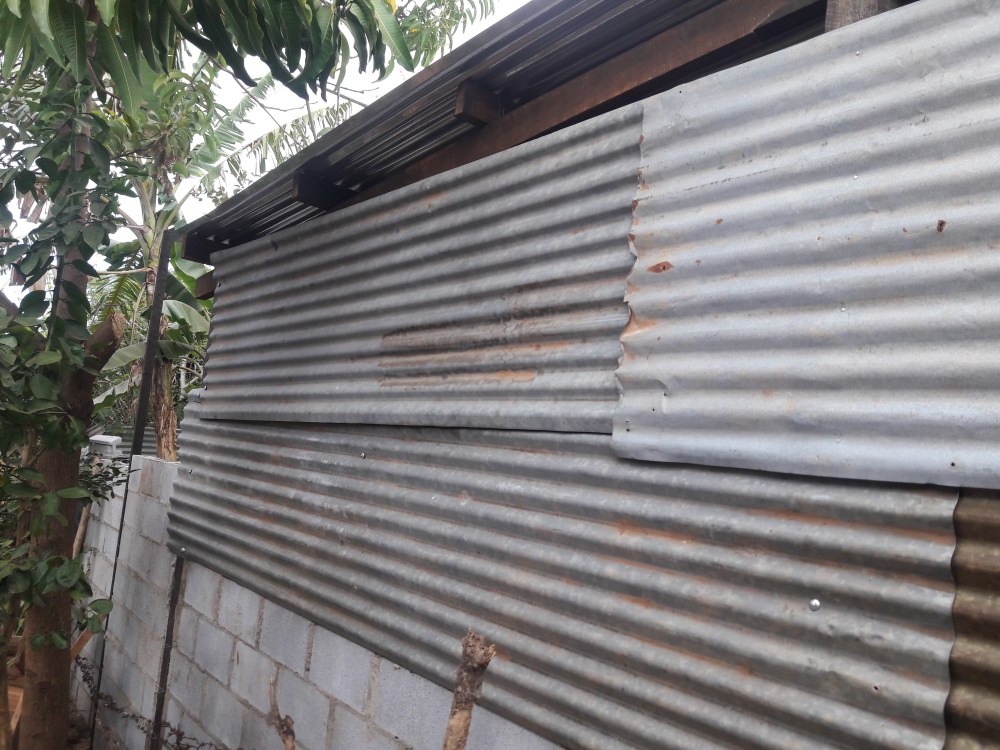

The base prep was about 4 inches of “ta pu he”, the chalky dirt pulled out of the latrine pit  from the bottom 7 feet. No compaction needed, just a little raking  to get out the big chunks.

20170131_144654

I hope it gets a clean tight finish at the top and a coat of paint. Somehow I don’t think that’s going to be a priority before my time is up here.

Construction progress Monday

We had 2 workers today. They were the b team for sure and didn’t know how to let Darvin and I help too much. But they made progress. The roof got up, so we got to take down most of the old house that was left inside.

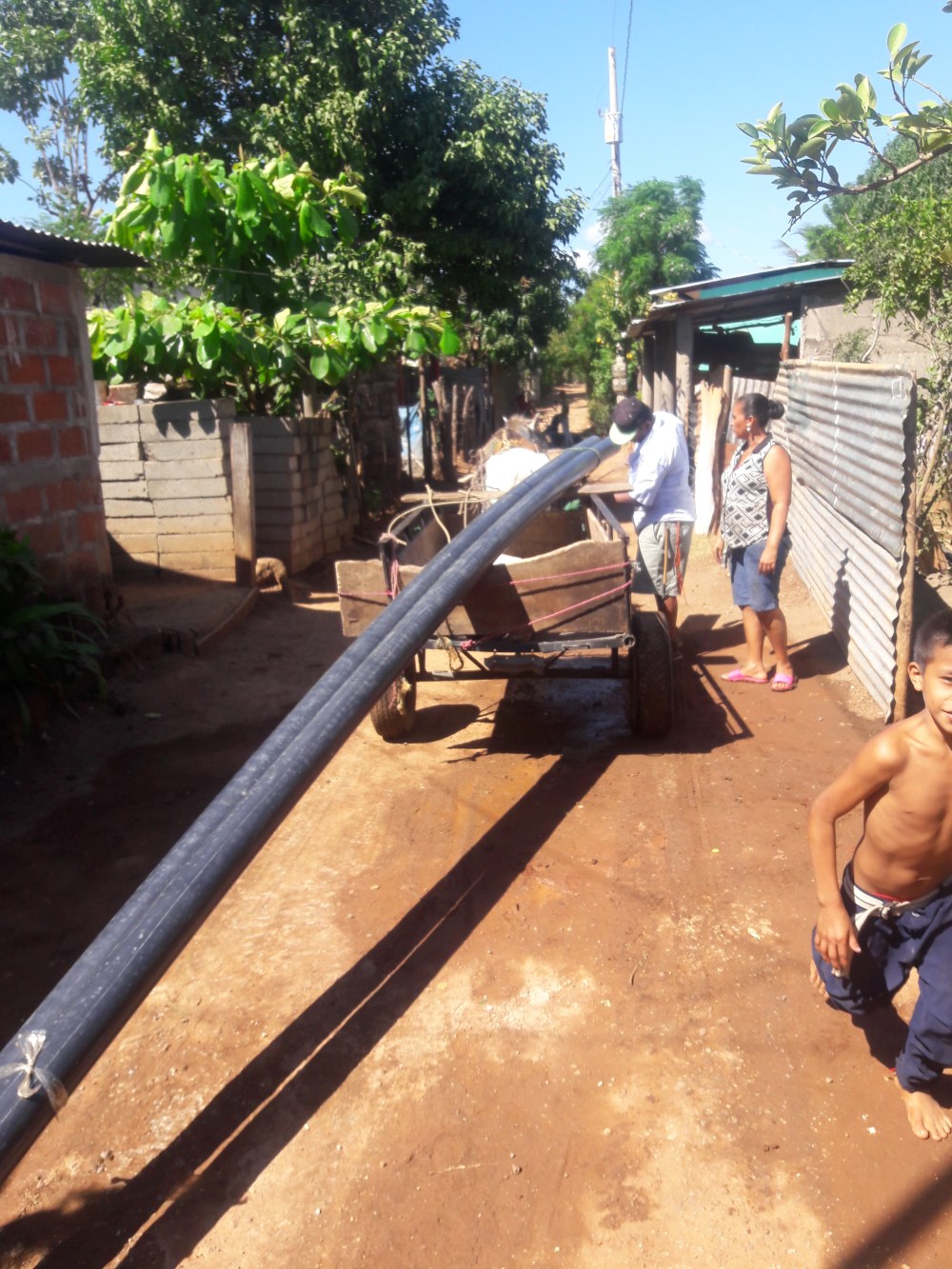

20170130_101518

 Donated drain pipe from friends in town. Darvin met me with the horse cart and we followed it up the hill on our bikes.

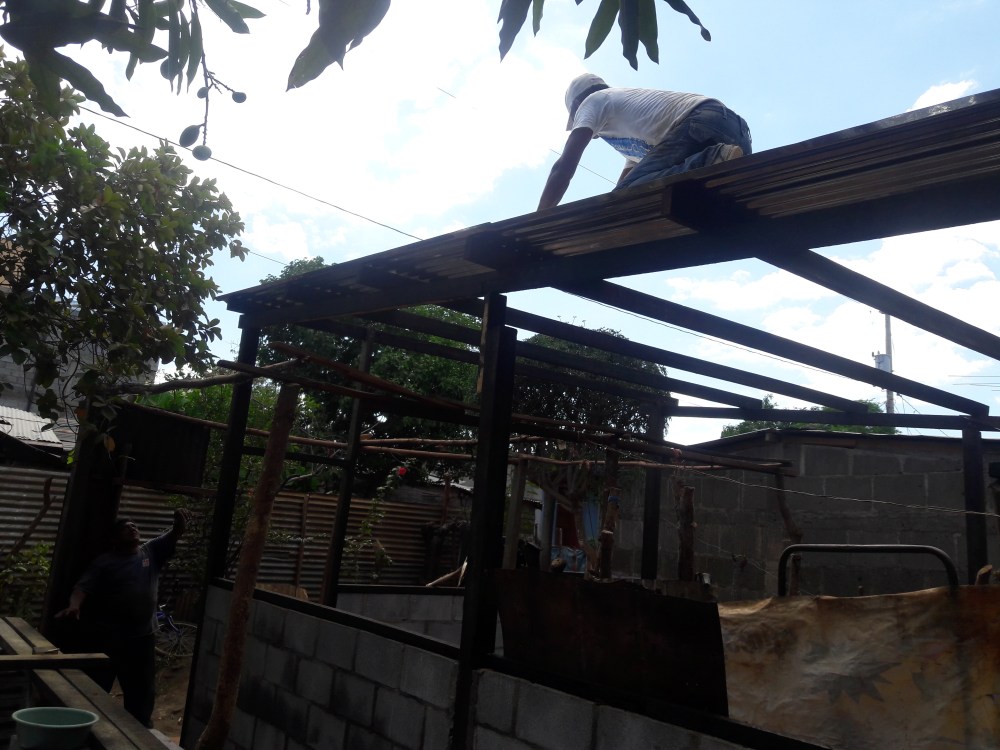

20170130_133506

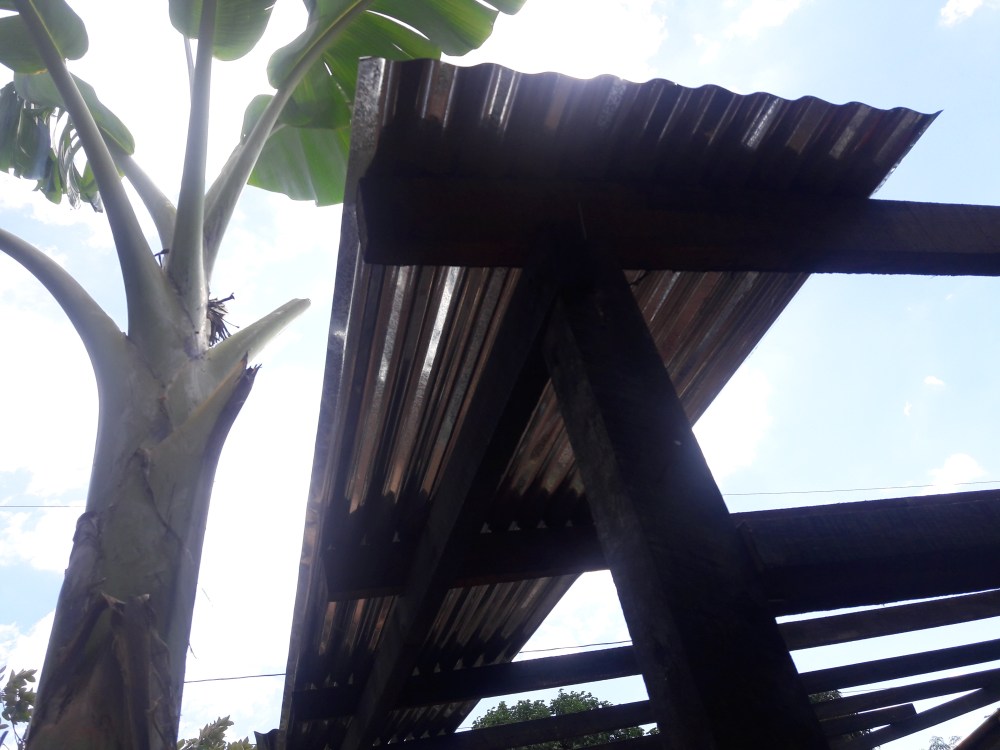

The zinc/tin roof panels feel like plastic, but are very strong. 2×4 rafters are 3 feet apart and this guy was walking all over up there.

20170130_133456

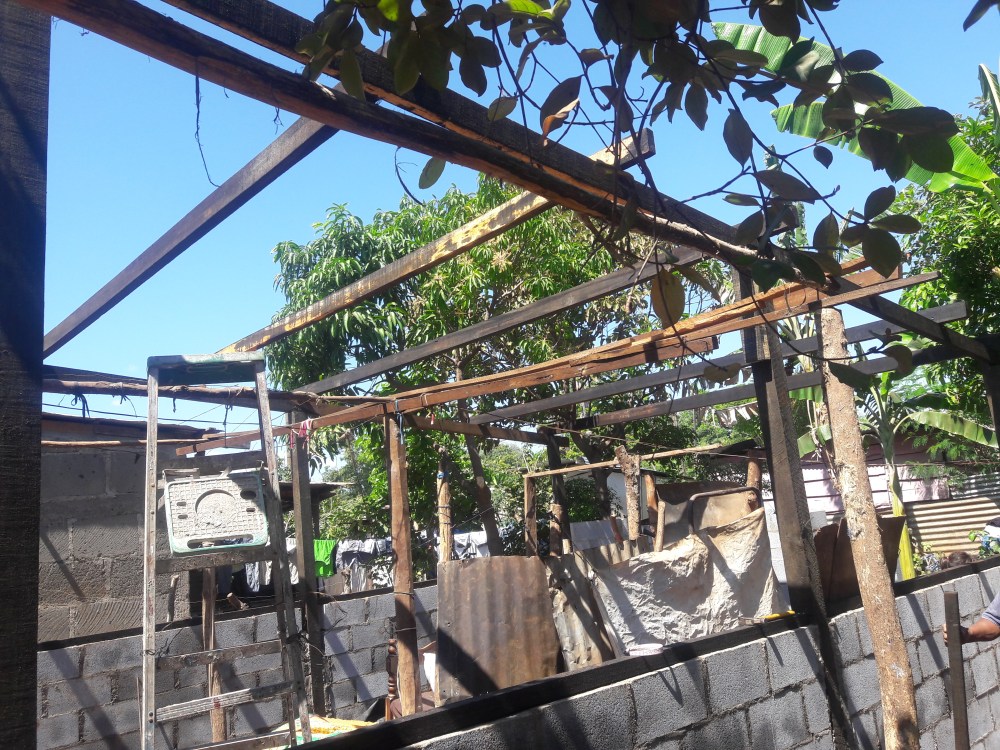

20170130_152036

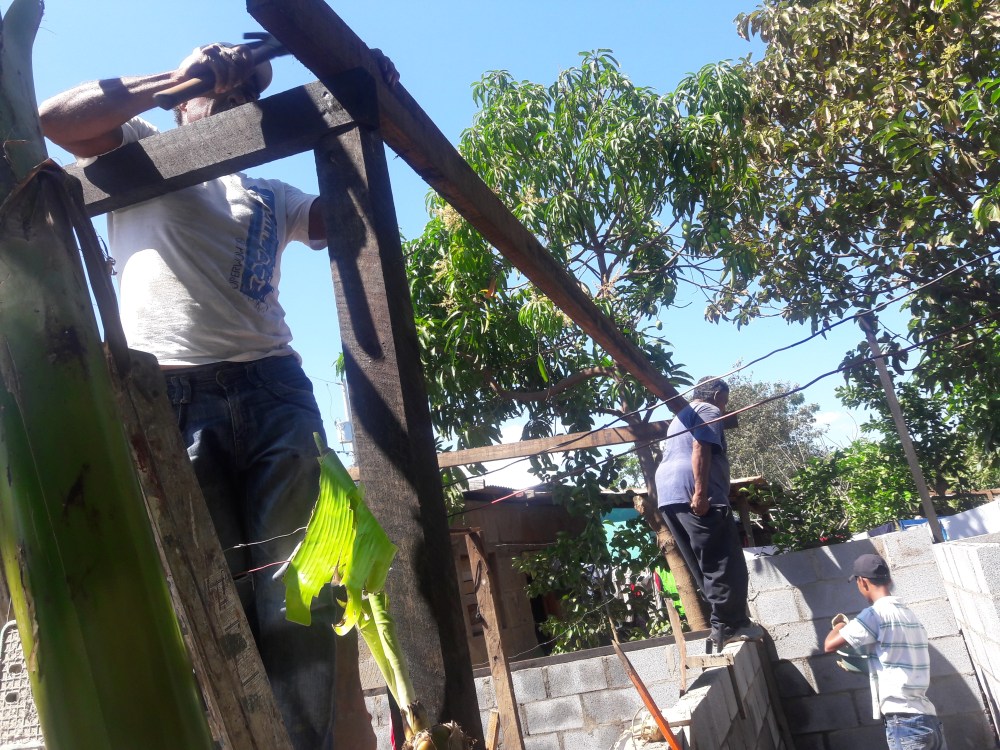

The back door framed.

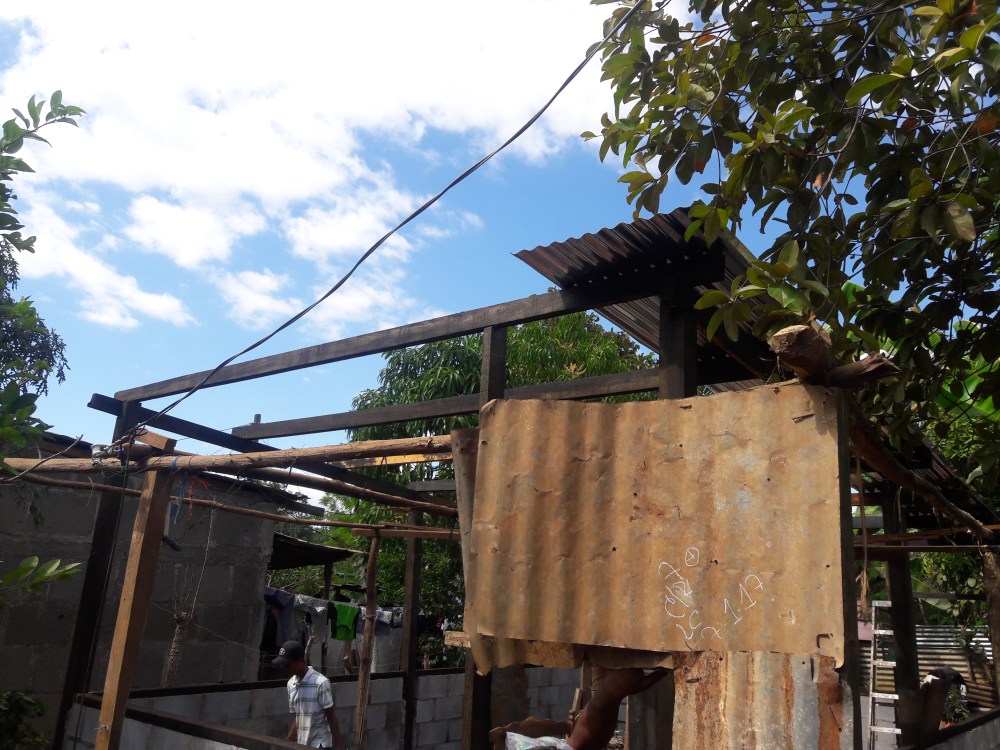

20170130_133658

The old front door remnants in front of the new house.

20170130_110425
20170130_152026

This 50+ year old, 250lbs dude was as slow as mollases all day. He was saving up for this. I left at 3:45 after he,was in there 30 minutes and had already gone another 2 feet deep.

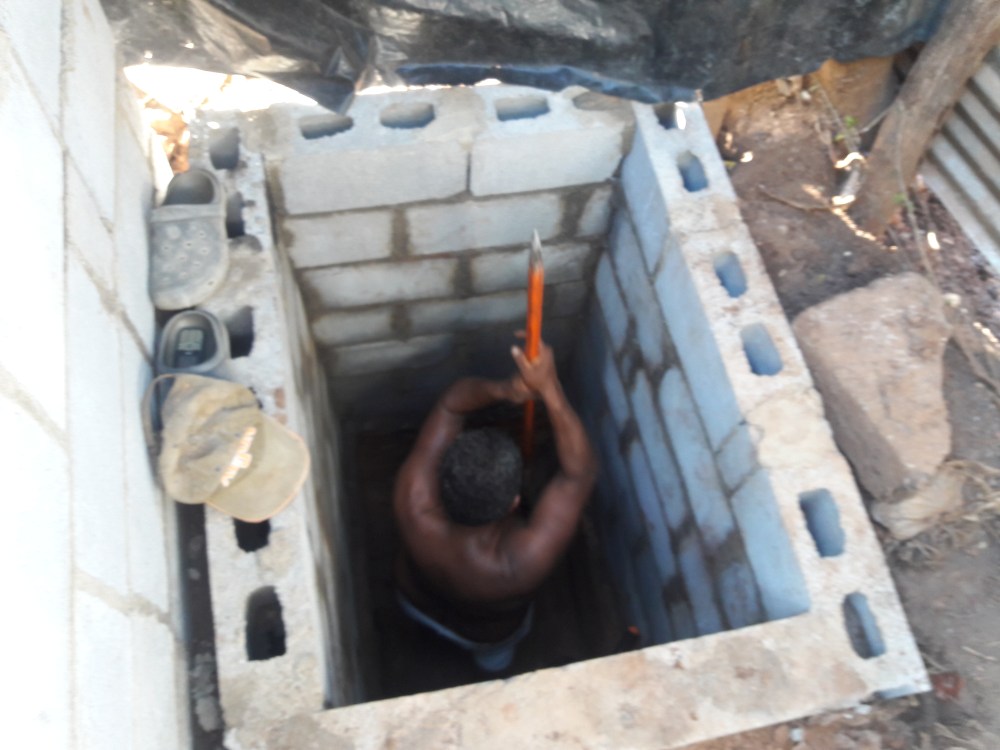

20170130_152018

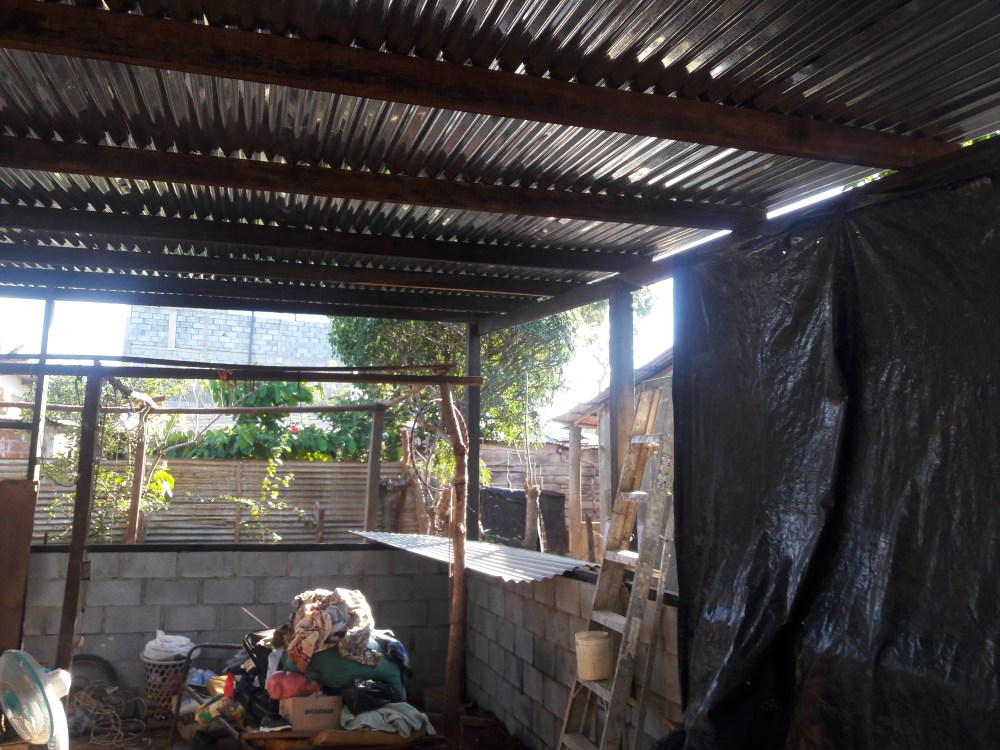

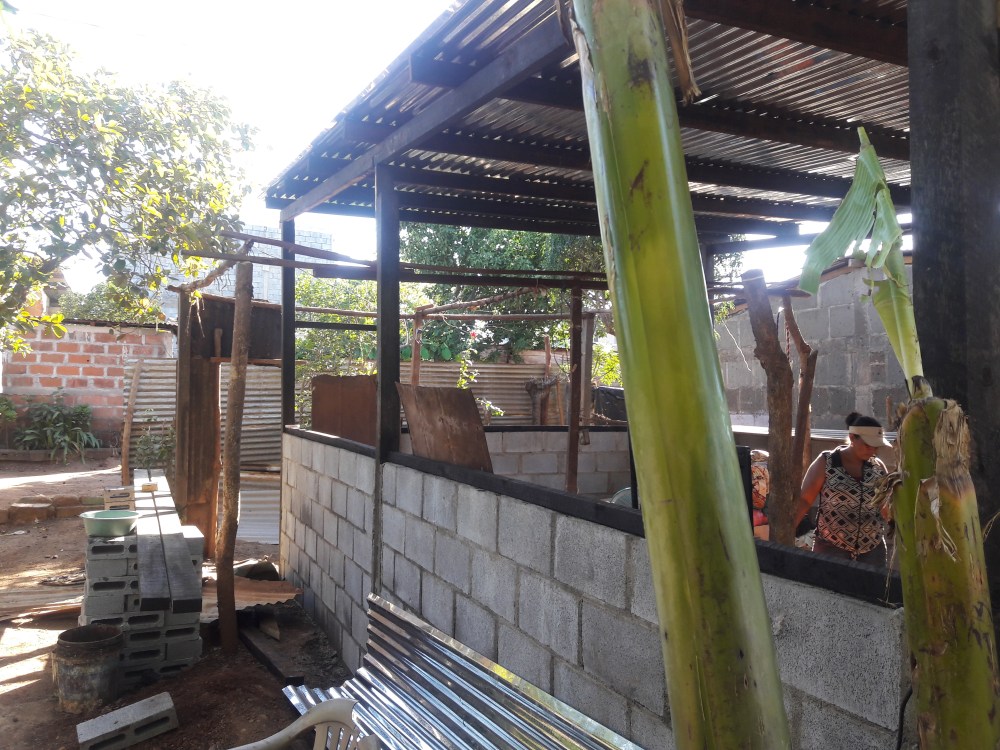

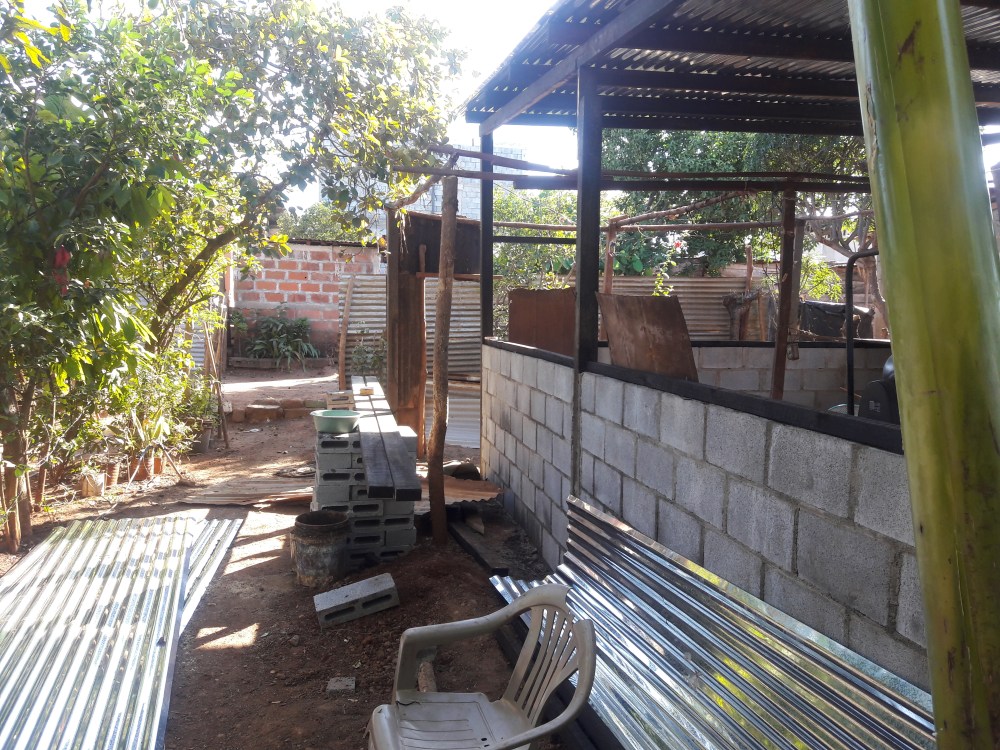

The finished roof and partially cleared out old house. Plastic upper wall will hopefully get replaced with wood tomorrow.

20170130_15201820170130_12004320170130_15204520170130_152048

Construction update, Sunday

Saturday is church day for much of the evangelical hillside barrios. So nothing happened yesterday and today the contractor’s latrine pit expert didn’t show up. So the family was there with a skilled friend making a little progress on the wood walls. I didn’t do any work, but got talk with the family about some of the options we can pursue after the basic house scope is completed.  Tomorrow should be much more productive, but we probably won’t be done with the basic stuff until Wed now. We’ll  be starting some small extras tomorrow, like drainage and maybe extending the water supply to the lavendera and shower. A few pictures from today.

20170129_124939

Darling, Darvin and their next door neighbor cousin Jose Francisco at the new North half wall with a little wood framing started.

20170129_125045

The new cooking area between the house and shower.

20170129_125043

Darling in the new shower, between cooking area and latrine. The roof is supposed to extend over all of these.

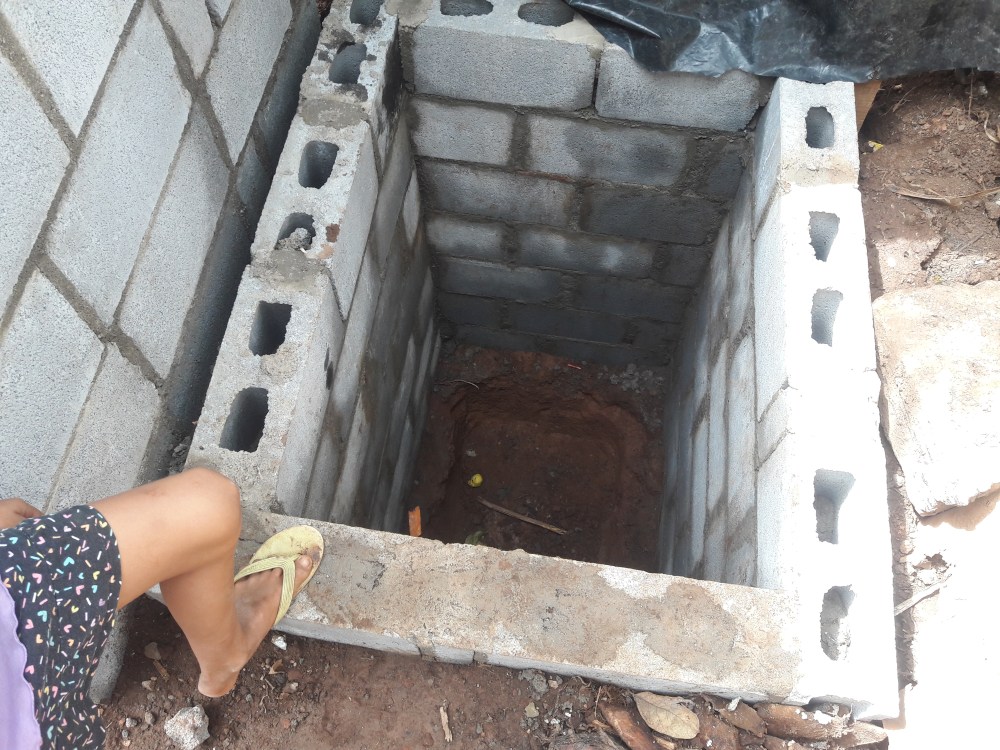

20170129_125027

The latrine, untouched since a few volunteers took some turns on Friday.

20170129_085054

Bonus pic: breakfast view from Kathy’s Waffle House this morning.

20170128_184055

Bonus pic: Masaya, Saturday night,1 of 3 craters in the world where public can look straight down into flowing lava. Lots of human sacrifice references from the tour guides.

20170128_170749

Bonus pic: Fort over looking Masaya built by Samoza regime with US help. Lots of very bad things in the 2 levels of underground prison cells. The run down tourist attraction is now loosely operated by the Boy Scouts.

Construction progess today, Friday

Today we had a big group of volunteers, 8 of us, that worked 10 -1:30.  We didn’t make it out there yesterday, so there was a tone of progress since Wed. The 4th wall got put up by the pros and a family friend, then we stuffed the top row with dirt, capped it with some concrete, the took bucket loads of the footing dirt out of the house. The old house is still pretty much intact. And thanks to us taking the large dirt pile out, they now have some room to spread out tonight.  This afternoon they were going start on the wood walls that start at the blocks you see in the pictures. No, the blocks do not have rebar for extra support. The block walls are only 4-5 ft tall, so the danger from earthquake damage is minimized by using wood up high.

We also found out today that the basic price for the house includes a free standing shower enclosure and new area for the cooking table. I hope to pick up some donated drain pipe on Monday so that we can help get the shower and sink water off their lot better. Once we do that, I hope we can keep going with more pipe to pick up the neighbors drainage too and get it a little further down the path. On Monday or Tuesday, we do the final talley  on the basic construction costs and see what more we can add. I confirmed just yesterday that the basic estimate of $3000 does not include a cement floor. I was told by several people that there maybe other priorities depending on the funding. We have about $4500 total. Our current list of upgrades for our $1500 include a floor, bunk beds for the 2 little kids, a gas  cooking stove (they burn tree limbs currently),  water supply connections to the sink and shower, a second sink/lavendera so they don’t have to wash clothes and dishes in the same place and use their 55 g drums to store water nearby, and more drainage. Hopefully we can do most of that, but there may be other things the family wants. Well ask the on Monday or Tuesday when the basic scope is done.

Today was also the last day of summer school at Nueva Esperanza. So we walked 5 minutes from the house to the school for festivities and a lot of goodbyes.

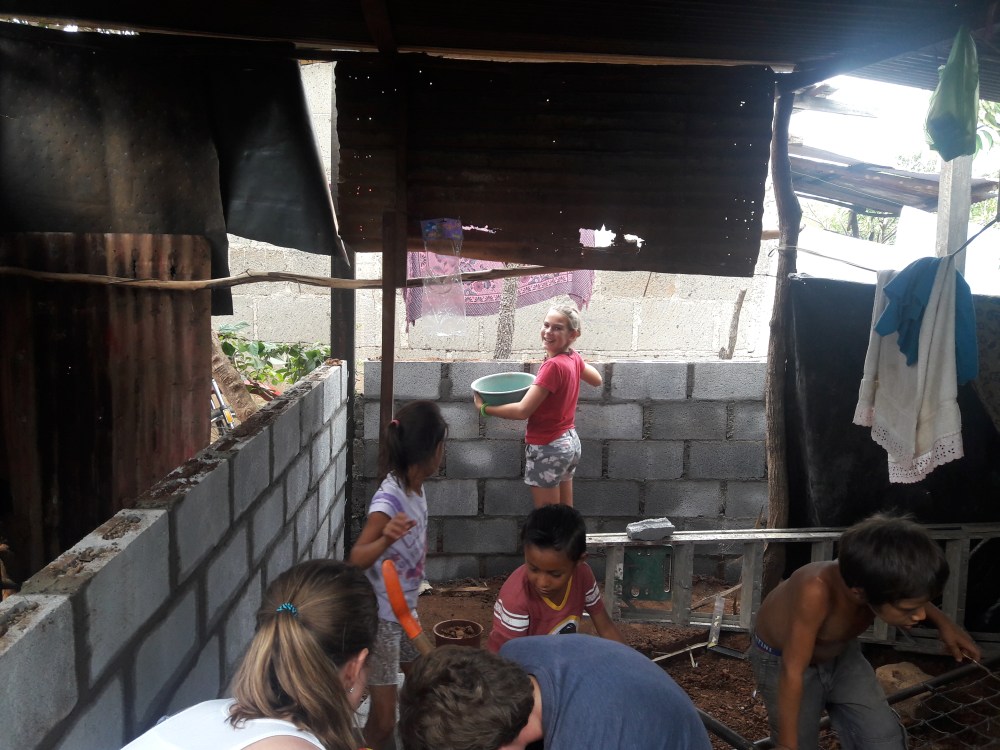

Next door cousins helping out.

20170127_114014

Olivia filling the blocks with dirt, for extra insulation I suppose.

20170127_105406

Attempting to get Anderson to promise me he will finish secondary school and go to university. I’m not too worried about him. I did get promises to finish secondary (high) school out of 3 other kids I’d consider at high risk of dropping out soon, but show lots of potential. I said Id check on them, so I guess we are coming back.

20170127_112122

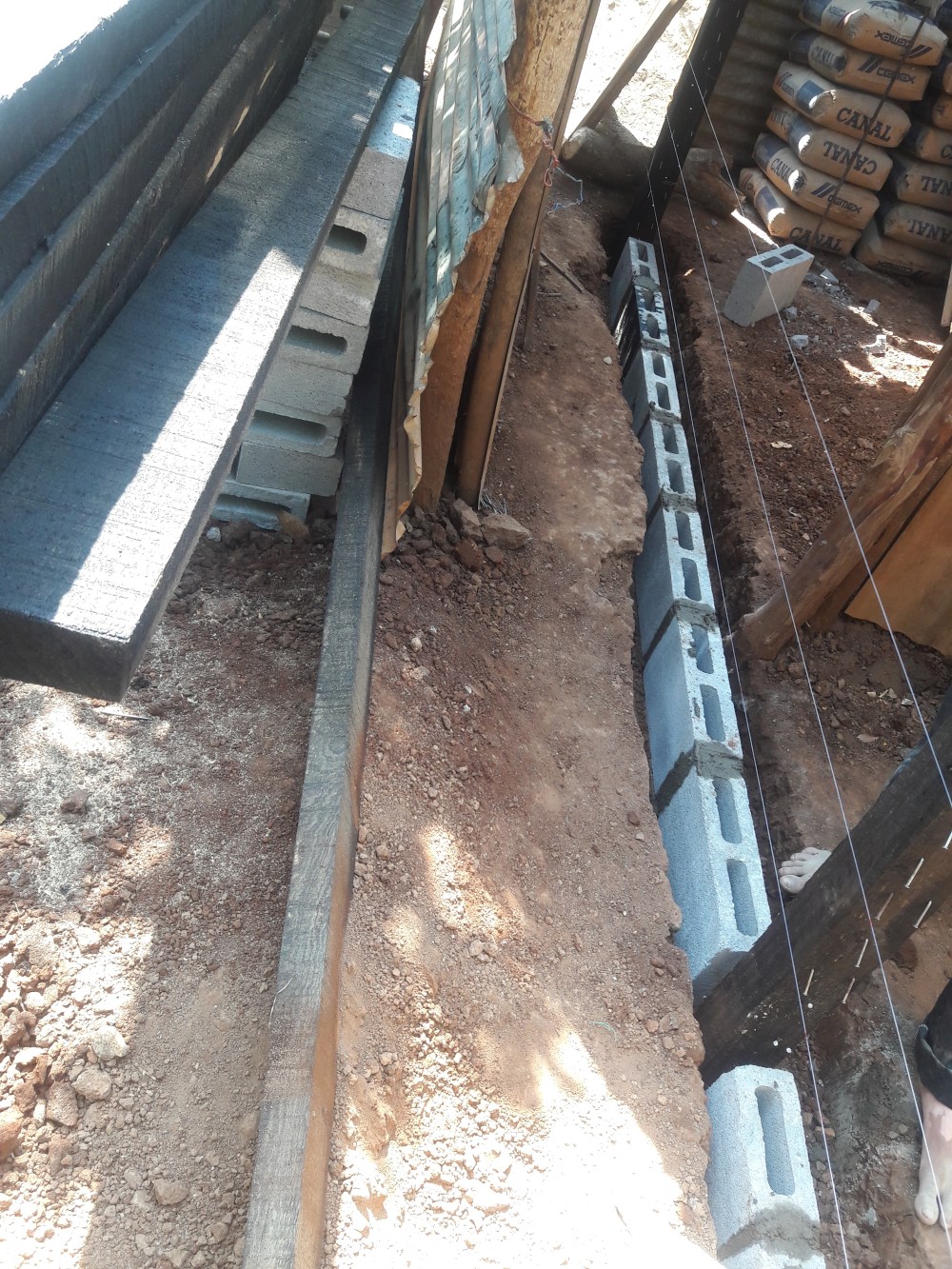

All the volunteers and Ayudantes.

20170127_101650

Olivia getting charmed by the class bully, Adrian. Very serious bully.

20170127_105144

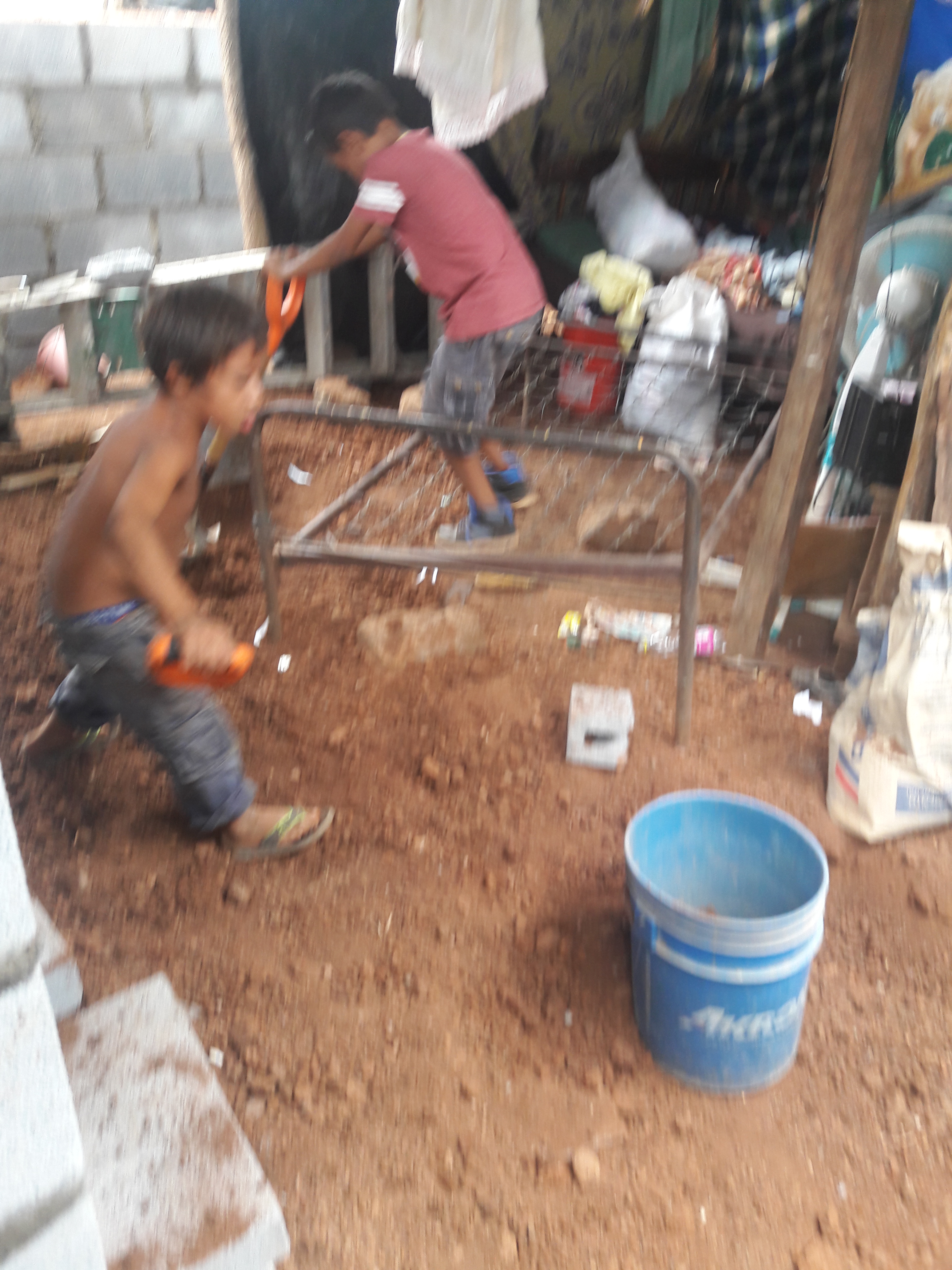

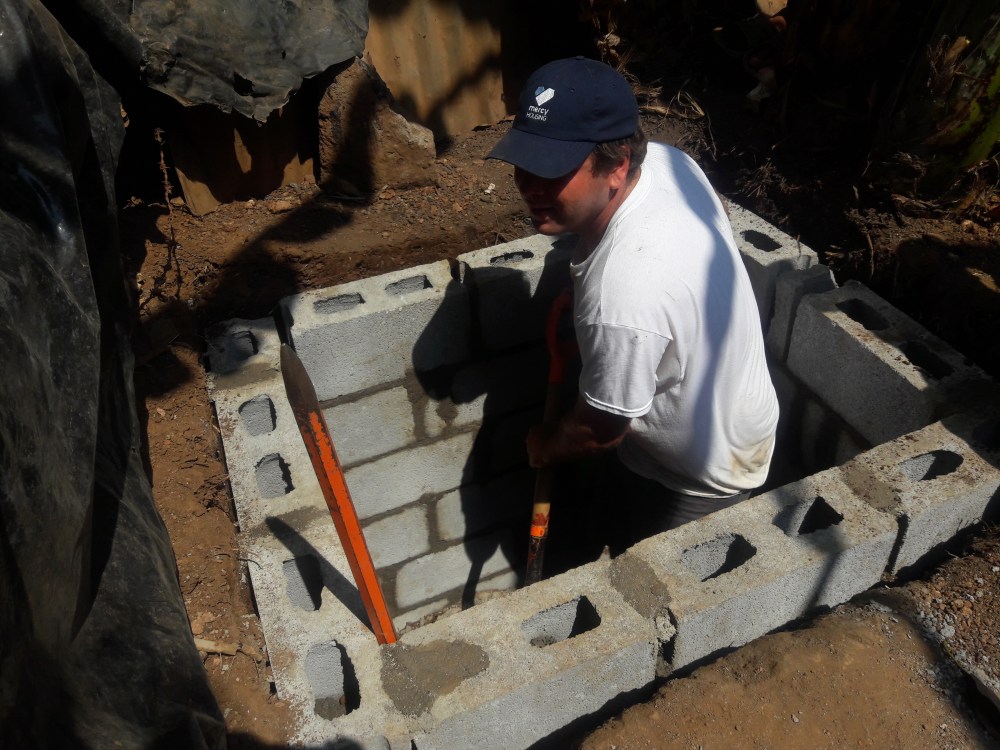

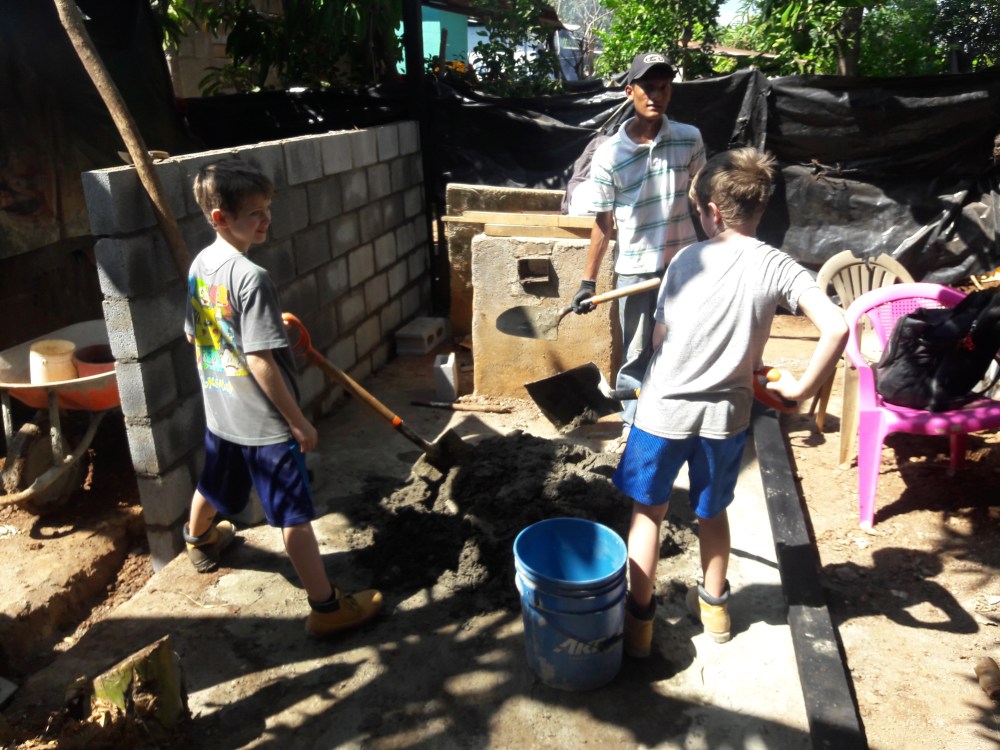

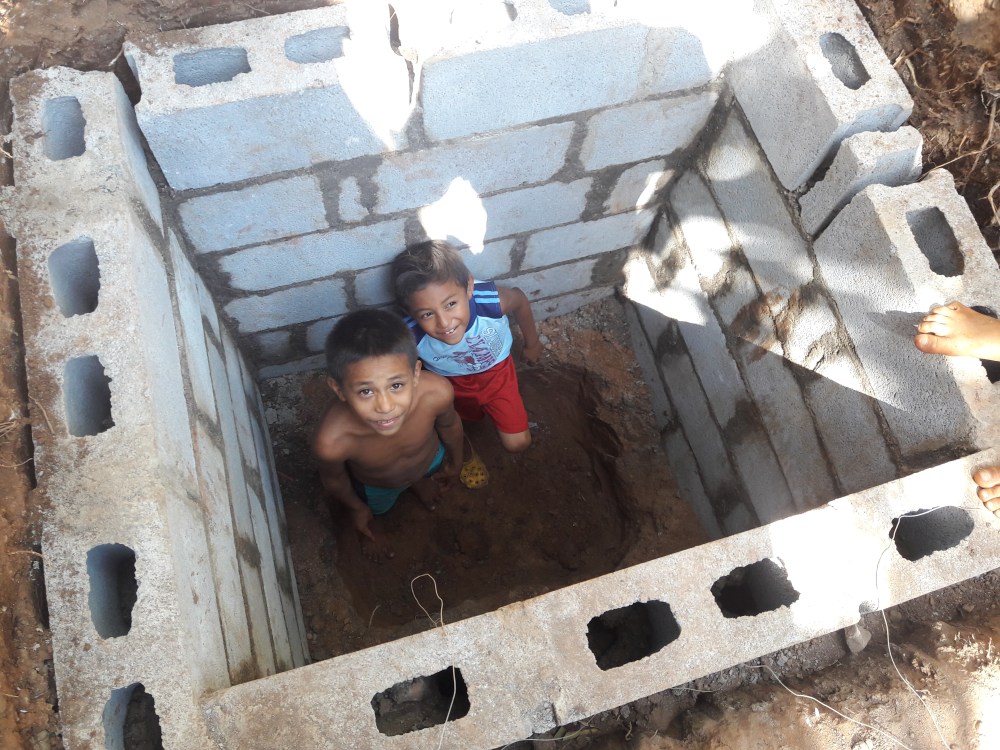

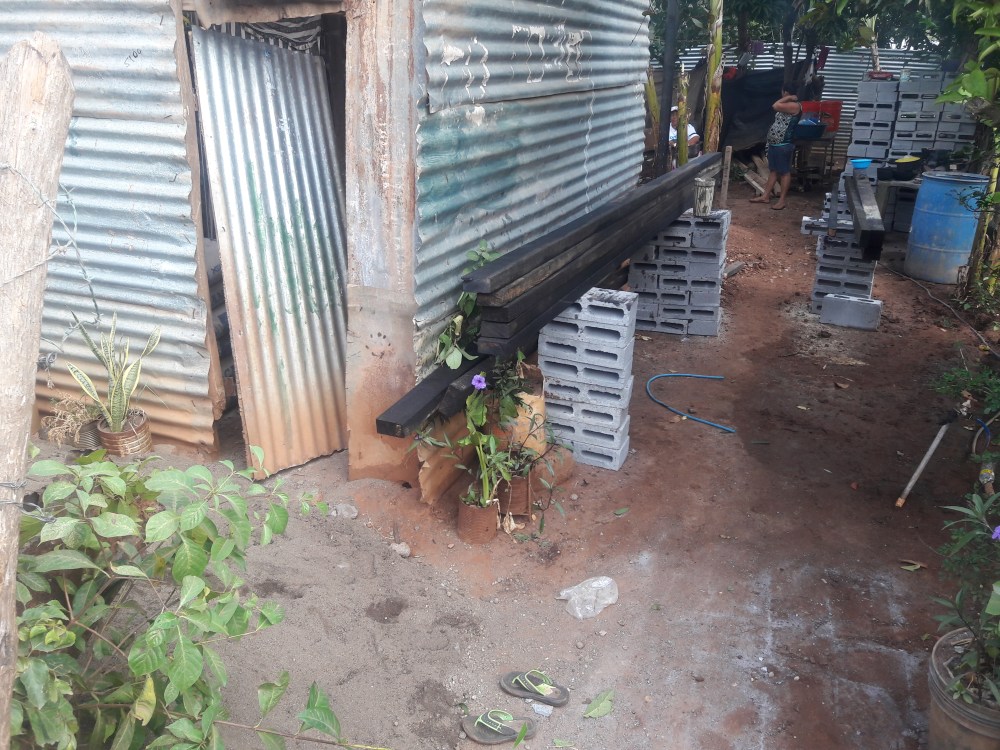

House construction progress thru Wed
